|
|||||
Project
Management MGMT627
VU
LESSON
04
PROJECT
MANAGEMENT METHODOLOGIES AND
ORGANIZATIONAL
STRUCTURES
Broad
Contents
Project
driven versus nonproject
driven organizations
Project
management methodologies
Systems,
programs, and projects
Categories
of projects
Product
versus Project
Management
Maturity
and excellence
Informal
Project Management
Organizational
structures
Selecting
the organizational form
4.1
Project
driven versus Non
project driven
organizations:
On
the micro level, virtually
all organizations are
marketing, engineering, or
manufacturing
driven.
But on the macro level,
organizations are either
project- or nonproject driven. In
a
project
driven organization, such as
construction or aerospace, all
work is characterized through
projects,
with each project as a
separate cost center having
its own profit-and-loss
statement.
The
total profit to the corporation is
simply the summation of the profits on
all projects. In a
project
driven organization, everything
centers on the projects. In the nonproject
driven
organization,
such as low technology
manufacturing, profit and loss is
measured on vertical or
functional
lines. In this type of
organization, projects exist merely to
support the product lines
or
functional lines. Priority
resources are assigned to the
revenue-producing functional
line
activities
rather than the projects.
Project
management in a nonproject driven
organization is generally more difficult
for these
reasons:
·
Projects
may be few and far
between.
·
Not
all projects have the same project
management requirements, and therefore,
they cannot
be
managed identically. This
difficulty results from poor
understanding of project
management
and a reluctance of companies to invest in
proper training.
·
Executives
do not have sufficient time to
manage projects themselves, yet
refuse to delegate
authority.
·
Projects
tend to be delayed because
approvals most often follow
the vertical chain of
command.
As a result, project work
stays too long in functional
departments.
·
Because
project staffing is on a "local"
basis, only a portion of the
organization understands
project
management and sees the system in
action.
·
There
exists heavy dependence on subcontractors
and outside agencies for
project
management
expertise.
Nonproject
driven organizations may
also have a steady stream of projects,
all of which are
usually
designed to enhance manufacturing operations.
Some projects may be
customer-
requested,
such as:
·
The
introduction of statistical dimensioning
concepts to improve process
control.
·
The
introduction of process changes to
enhance the final
product.
·
The
introduction of process change
concepts to enhance product
reliability.
21
Project
Management MGMT627
VU
If
these changes are not
identified as specific projects, the
result can be:
·
Poorly
defined responsibility areas
within the organization.
·
Poor
communications, both internal and
external to the organization.
·
Slow
implementation.
·
Lack
of a cost tracking system
for implementation.
·
Poorly
defined performance criteria.

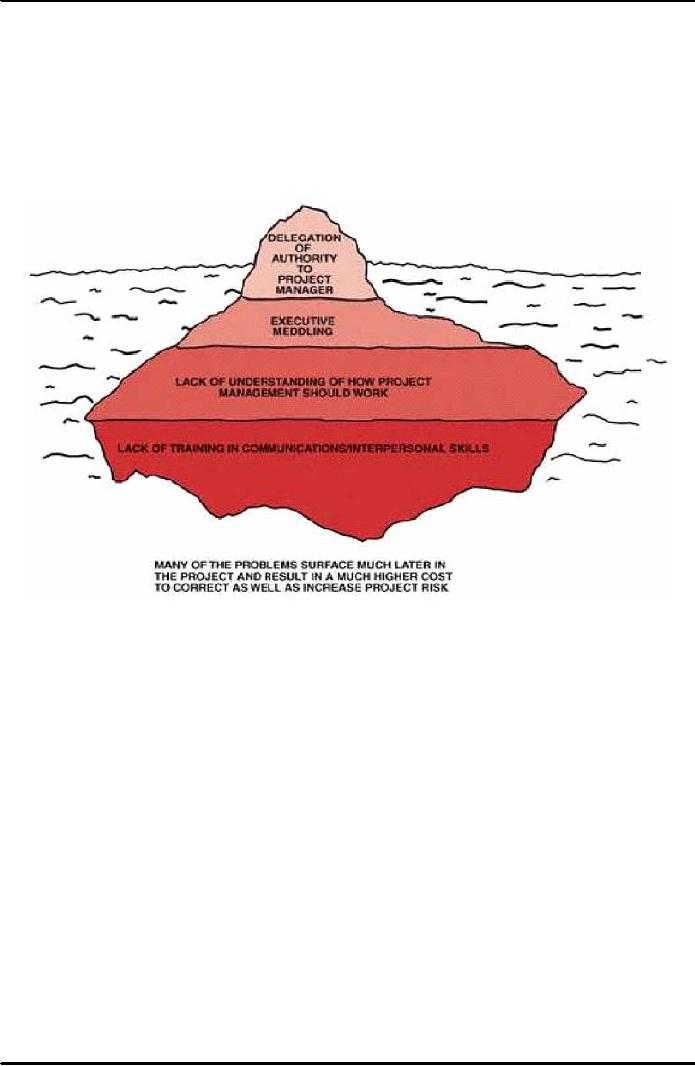

Figure
4.1 below shows the
tip-of-the-iceberg syndrome, which can
occur in all types of
organizations
but is most common in nonproject
driven organizations.
Figure
4.1: The
tip-of-the-iceberg syndrome for
matrix implementations.
On
the surface, all we see is a
lack of authority for the
project manager. But beneath the
surface
we
see the causes; there is excessive
meddling due to lack of understanding of
project
management,
which, in turn, resulted from an
inability to recognize the need for
proper training.
In
the previous sections we stated
that project management
could be handled on either a
formal
or
an informal basis. Informal
project management most
often appears in nonproject
driven
organizations.
It is doubtful that informal
project management would
work in a project
driven
organization
where the project manager has
profit and loss
responsibility.
In
reality, most firms that
believed that they were
nonproject driven were actually
hybrids.
Hybrid
organizations are typically
nonproject driven firms
with one or two divisions
that are
project
driven.
Historically,
hybrids have functioned as though
they were nonproject driven, as
shown in
Figure
4.2, but today they

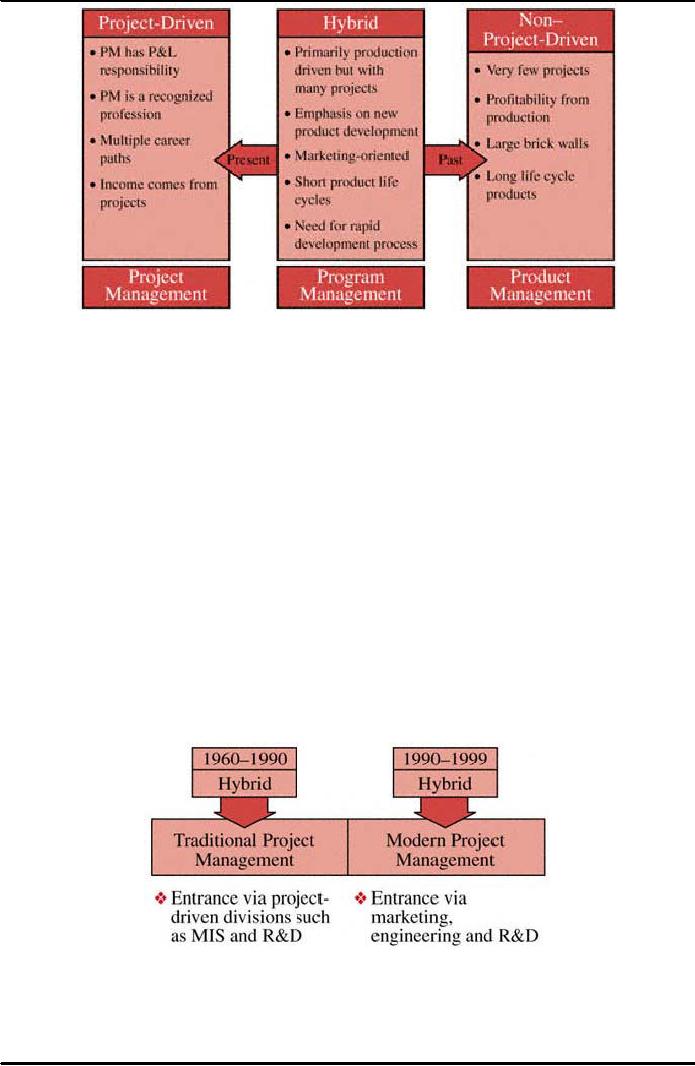

are functioning like project
driven firms.
22
Project
Management MGMT627
VU
Figure
4.2: Project
driven versus non-project
driven organizations
4.2
Project
Management Methodologies:
Earlier
there were no allies or alternative
management techniques that were promoting
the use
of
project management. The
recession of 19891993 finally
saw the growth of
project
management
in the nonproject driven sector.
This recession was characterized by
layoffs in the
white
collar/management ranks. Allies for
project management were appearing and
emphasis
was
being placed upon long-term
solutions to problems. Project management
was now here to
stay.
The allies for project
management began surfacing in
1985 and continued throughout
the
recession

of 19891993.
·
1985: Companies
recognized that they must
compete on the basis of quality as
well as cost.
There
existed a new appreciation
for Total
Quality Management (TQM).
Companies
began
using the principles of project
management for the implementation of
TQM. The first
ally
for project management
surfaced with the "marriage" of
project management and
TQM.
·
1990: During
the recession of 19891993, companies
recognized the importance of
schedule
compression and being the first to
market. Advocates of concurrent
engineering
began
promoting the use of project
management to obtain better
scheduling techniques.
Another
ally for project management
was born.
Figure
4.3: From

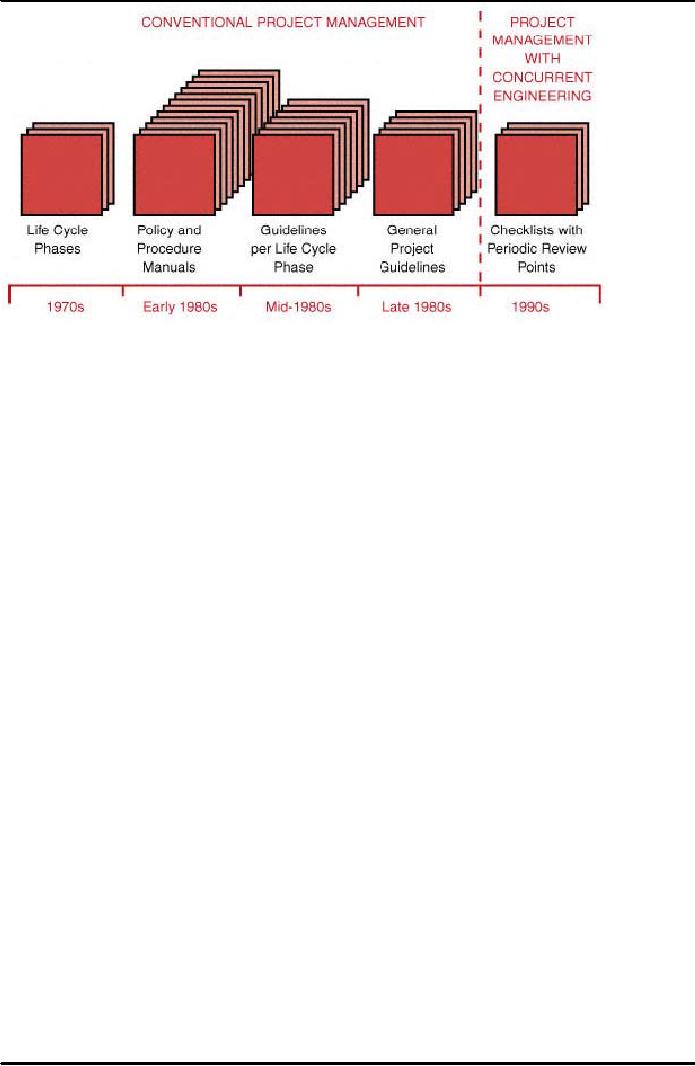

hybrid to project-driven.
19911992:
Executives
realized that project
management works best if
·
decision-making
and authority are decentralized. They
further recognized
that
control could still be achieved at the
top by functioning as project
sponsors.
23
Project
Management MGMT627
VU
·
1993: As
the recession of 19891993 came to an
end, companies began
"re-engineering"
the
organization, which really amounted to
elimination of organizational "fat."
The
organization
was now a "lean and mean"
machine. People were asked to do more work
in
less
time and with fewer
people; executives recognized that being
able to do this was a
benefit
of project management.
Figure
4.4: New
processes supporting project
management.
·
1994: Companies
recognized that a good project
cost control system (i.e.,
horizontal
accounting)
allows for improved
estimating and a firmer grasp of the
real cost of doing
work
and developing products.
·
1995: Companies
recognized that very few projects were
completed within the framework
of
the original objectives without
scope changes. Methodologies were
created for effective
change
management.
·
1996: Companies
recognized that risk management
involves more than padding an
estimate
or
a schedule. Risk management plans were
now included in the project
plans.
·
1997-1998: The
recognition of project management as a
professional career path
mandates
the
consolidation of project management
knowledge and a centrally located
project
management
group.
Figure
4.5: Integrated
Processes (Past, present,
and future)
·
1999: Companies
that recognized the importance of concurrent
engineering and rapid
product
development found that it
was best to have dedicated resources
for the duration of
the
project. The cost of over
management may be negligible
compared to risks of under
management.
More and more organizations could be
expected to use collocated teams
all
housed
together.
24
Project
Management MGMT627
VU
·
2000: Mergers
and acquisitions were creating more
multinational companies. It
was
believed
that multinational project
management will become the
major challenge for
the
next
decade.
The
reason for the early
resistance to project management
was that the necessity for
project
management
was customer-driven rather than
internally driven, despite the existence of
allies.
Project
management was being
implemented, at least partially,
simply to placate customer
demands.
By 1995, however, project
management had become
internally driven and a
necessity
for
survival. Project management
benchmarking was commonplace, and
companies recognized
the
importance of achieving excellence in
project management.
As
project management continues to grow and
mature, more allies will appear. In the
twenty-
first
century, second and third
world nations will come to
recognize the benefits and
importance
of
project management. Worldwide
standards for project
management will
occur.
4.3
Systems,
Programs, and Projects:
4.3.1
Systems:
In
the preceding sections the word "systems"
has been used rather
loosely. The exact
definition
of a system depends on the users,
environment, and ultimate goal.
Modern
business
practitioners define a system
as:
A
group of elements, either human or nonhuman,
that is organized and arranged
in
such
a way that the elements
can act as a whole toward
achieving some
common
goal,
objective, or end.
Systems
are collections of interacting
subsystems that either span
or interconnect all
schools
of management. Systems, if properly
organized, can provide a
synergistic
output.
Systems are characterized by their
boundaries or interface conditions.
For
example,
if the business firm system
were completely isolated from the
environmental
system,
then a close
system
would exist, in which case
management would have
complete
control over all system
components. If the business system
does in fact react
with
the environment, then the system is
referred to as open. All social
systems, for
example,
are categorized as open systems. Open
systems must have permeable
boundaries.
4.3.2
Programs:
Programs
can be explained as the necessary
first-level elements of a system.
Two
representative
definitions of programs are
given below:
·
Air
Force Definition: The
integrated, time-phased tasks necessary
to accomplish a
particular
purpose.
·
NASA
Definition: A
relative series of undertakings
that continue over a period
of
time
(normally years) and that
are designed to accomplish a broad,
scientific or
technical
goal in the NASA long range plan
(lunar and planetary
exploration,
manned
spacecraft systems). Programs
can be regarded as subsystems.
However,
programs
are generally defined as time-phased
efforts, whereas systems
exist on a
continuous
basis.
4.3.3
Projects:
Projects
are also time-phased efforts (much
shorter than programs) and are the
first
level
of breakdown of a program. A typical
definition would be:
·
NASA/Air
Force Definition: A
project is within a program as an
undertaking that
has
a scheduled beginning and end, and
that normally involves some
primary
25
Project
Management MGMT627
VU
purpose.
The majority of the industrial sector, on
the other hand, prefers to
describe
efforts
as projects, headed by a project manager.
Whether we call our
undertaking
project
management or program management is
inconsequential because the
same
policies,
procedures, and guidelines that
regulate programs most often
apply to
projects
also. For the remainder of this text,
programs and projects will be
discussed
interchangeably.
However, the reader should be
aware that projects are
normally
the
first-level subdivision of a
program.
4.4
Categories
of Projects:
Once
a group of tasks is selected and
considered to be a project, the next step
is to define the
kinds
of project units. There are
four categories of projects:
1.
Individual
projects: These
are short-duration projects normally
assigned to a single
individual
who may be acting as both a
project manager and a functional
manager.
2.
Staff
projects: These
are projects that can be accomplished by
one organizational unit, say
a
department.
3.
Special
projects: Very
often special projects occur that require
certain primary
functions
and/or
authority to be assigned temporarily to
other individuals or units.
This works best
for
short-duration
projects. Long-term projects can lead to
severe conflicts under
this
arrangement.
4.
Matrix
or Aggregate projects: These
require input from a large
number of functional units
and
usually control vast
resources. Each of these
categories of projects can require
different
responsibilities,
job descriptions, policies, and
procedures. Project management
may now be
defined
as the process of achieving project
objectives through the traditional
organizational
structure
and over the specialties of the
individuals concerned. Project
management is
applicable
for any ad hoc (unique,
one-time, one-of-a-kind) undertaking
concerned with a
specific
end objective. In order to complete a task, a
project manager must:
·
Set
objectives
·
Establish
plans
·
Organize
resources
·
Provide
staffing
·
Set
up controls
·
Issue
directives
·
Motivate
personnel
·
Apply
innovation for alternative
actions
·
Remain
flexible
The
type of project will often
dictate which of these
functions a project manager
will be
required
to perform.
4.5
Product
versus Project Management:
For
all practical purposes, there is no
basic difference between program
management and
project
management. Project management and
product management are
similar, with one
major
exception:
the
project manager focuses on the end
date of his project, whereas
the product
manager
is not willing to admit that
his product line will ever
end. The
product manager wants
his
product to be as long-lived and
profitable as possible. Even when the
demand for the
product
diminishes, the product manager
will always look for
spin-offs to keep his
product
alive.
When the project is in the Research
and Development (R & D) phase, a
project manager
is
involved. Once the product is
developed and introduced into the
marketplace, control is taken
26
Project
Management MGMT627
VU
over
by the product manager. In some
situations, the project manager
can become the
product
manager.
Both product and project
management can, and do,
exist concurrently
within
companies.
4.6
Maturity
and Excellence:
Some
people think that maturity
and excellence in project management
are the same.
Unfortunately,
this is not the case. Consider the
following definition:
Maturity
in project management is the
implementation of a standard methodology
and
accompanying
processes, in such a way
that ensures a high
likelihood of repeated
successes.
This
definition is supported by the life-cycle
phases. Maturity implies
that the proper
foundation
of
tools, techniques, processes, and even
culture, exists. When projects come to an
end, there is
usually
a debriefing with senior management to
discuss how well the
methodology was used
and
to recommend changes. This
debriefing looks at ''key performance
indicators," and
allows
the
organization to maximize what it
does right and to correct what it
did wrong.
The
definition of excellence can be stated
as:
Organizations
excellence creates an environment in
which there exists a
continuous stream of
successfully
managed projects and where
success is measured by what is in the
best interest of
both
the company and the project
(i.e. the customer)
Excellence
goes well beyond maturity.
You must have maturity to achieve excellence. It
may
take
two years or more to reach
some initial levels of
maturity. Excellence, if achievable at
all,
may
take an additional five
years or more.
4.7
Informal
Project Management:
Companies
today are managing projects more on an
informal basis than on a
formal one.
Informal
project management does have
some degree of formality but
emphasizes managing the
project
with a minimum amount of paperwork. A
reasonable amount of formality still
exists.
Furthermore,
informal project management is
based upon guidelines rather
than the policies and
procedures
that are the basis for
formal project management.
This was shown previously to be
a
characteristic
of a good project management
methodology. Informal project
management
mandates:
·
Effective
communications
·
Effective
cooperation
·
Effective
teamwork
·
Trust
These
four elements are absolutely
essential for informal
project management to
work
effectively.
27
Project
Management MGMT627
VU
Figure
4.6: Evolution
of policies, procedures, and
guidelines.
Not
all companies have the luxury of
using informal project
management. Customers often
have
a
strong voice in whether formal or
informal project management
will be used.
4.8
Organizational
Structures:
During
the past thirty years there
has been a so-called hidden
revolution in the introduction and
development
of new organizational structures.
Management has come to
realize that
organizations
must be dynamic in nature;
that is, they must be
capable of rapid restructuring,
if
environmental
conditions so dictate. These
environmental factors evolved from the
increasing
competitiveness
of the market, changes in technology,
and a requirement for better
control of
resources
for multiproduct firms. More
than thirty years ago,
Wallace identified four
major
factors
that caused the onset of the
organizational revolution:
·
The
technology revolution (complexity and
variety of products, new materials
and
processes,
and the effects of massive
research).
·
Competition
and the profit squeeze (saturated
markets, inflation of wage and
material costs,
and
production efficiency).
·
The
high cost of
marketing.
·
The
unpredictability of consumer demands
(due to high income, wide range of
choices
available,
and shifting tastes).
Much
has been written about
how to identify and interpret
those signs that indicate
that a new
organizational
form may be necessary.
According to Grinnell and Apple, there
are five general
indications
that the traditional structure may
not be adequate for managing
projects:
·
Management
is satisfied with its
technical skills, but projects
are not meeting time,
cost, and
other
project requirements.
·
There
is a high commitment to getting
project work done, but great
fluctuations in how
well
performance
specifications are
met.
·
Highly
talented specialists involved in the
project feel exploited and
misused.
·
Particular
technical groups or individuals
constantly blame each other
for failure to meet
specifications
or delivery dates.
·
Projects
are on time and to specifications,
but groups and individuals are
not satisfied with
the
achievement.
28
Project
Management MGMT627

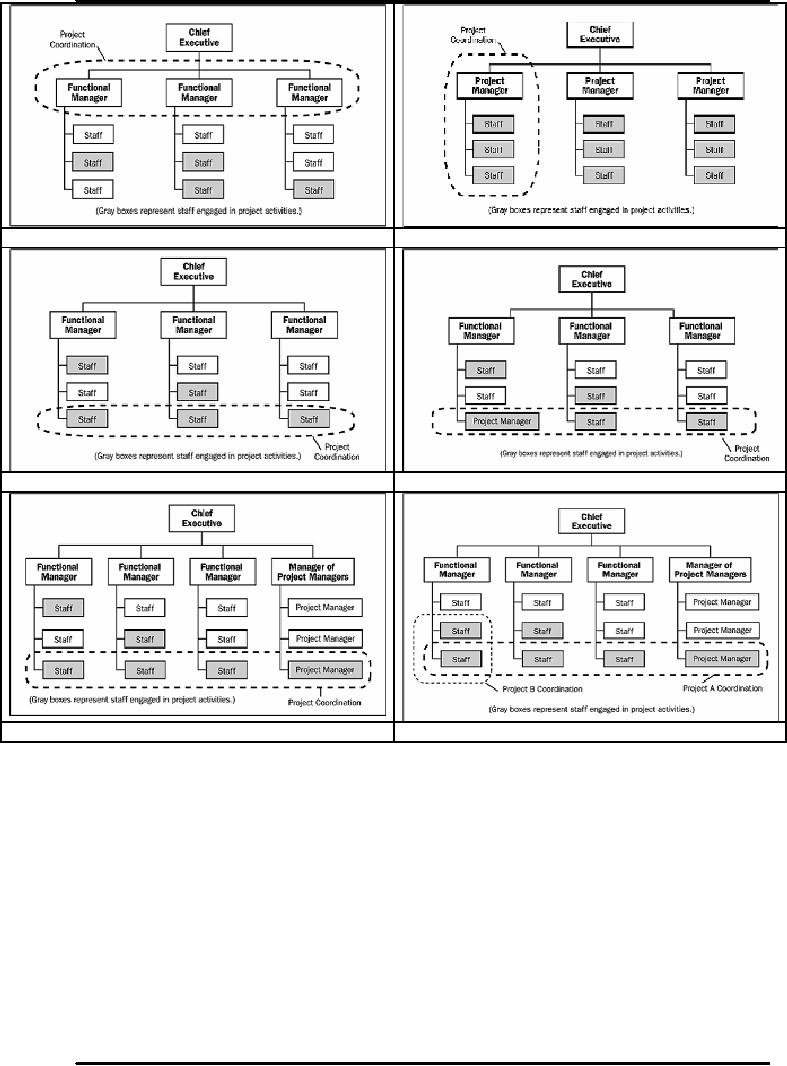

VU
Figure
4.7: Functional
Organization
Figure
4.8: Project
Organization
Figure
4.9: Weak
Matrix Organization
Figure
4.10: Balanced
Matrix Organization
Figure
4.11: Strong
Matrix Organization
Figure
4.12: Composite
Organization
Unfortunately,
many companies do not
realize the necessity for
organizational change until it
is
too
late. Management continually
looks externally (i.e., to the
environment) rather than
internally
for solutions to problems. A typical
example would be that new
product costs are
continually
rising while the product
life cycle may be
decreasing. Should emphasis be placed
on
lowering
costs or developing new
products?
For
each of the organizational
structures described in the following
sections, advantages and
disadvantages
are listed. Many of the
disadvantages stem from possible
conflicts arising
from
problems
in authority, responsibility, and
accountability. The reader
should identify these
conflicts
as such.
4.8.1
Traditional
(Classical) Organization:
The
traditional management structure has
survived for more than two
centuries.
However,
recent business developments, such as the
rapid rate of change in
technology
and
position in the marketplace, as well as
increased stockholder demands, have
created
29
Project
Management MGMT627
VU
strains
on existing organizational forms.
Fifty years ago companies
could survive with
only
one or perhaps two product
lines. The classical
management organization
was
found
to be satisfactory for control, and
conflicts were at a minimum.
However,
with the passing of time,
companies found that
survival depended on
multiple
product
lines (that is diversification) and
vigorous integration of technology
into the
existing
organization. As organizations grew and
matured, managers found
that
company
activities were not being
integrated effectively, and
that new conflicts
were
arising
in the well-established formal and
informal channels.
Managers
began searching for more innovative
organizational forms that
would
alleviate
the integration and conflict problems.
The advantages and disadvantages
of
this
type of organizations are
listed in tables 4.1 and 4.2
respectively.
Table

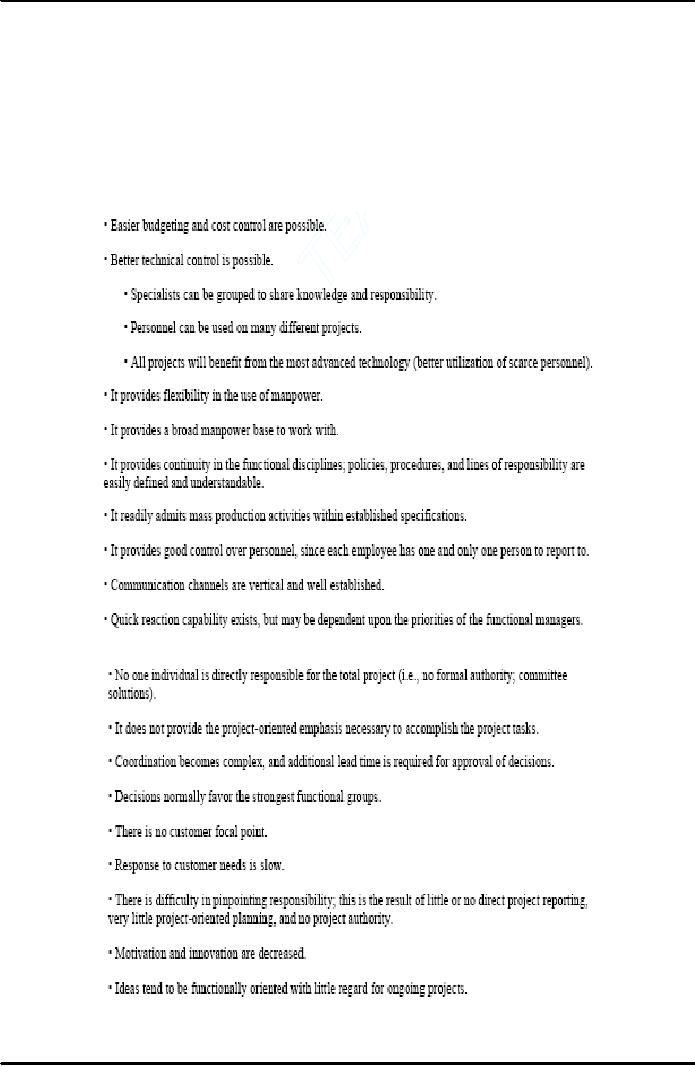

4.1: Advantages
of the traditional/classical
organization
Table

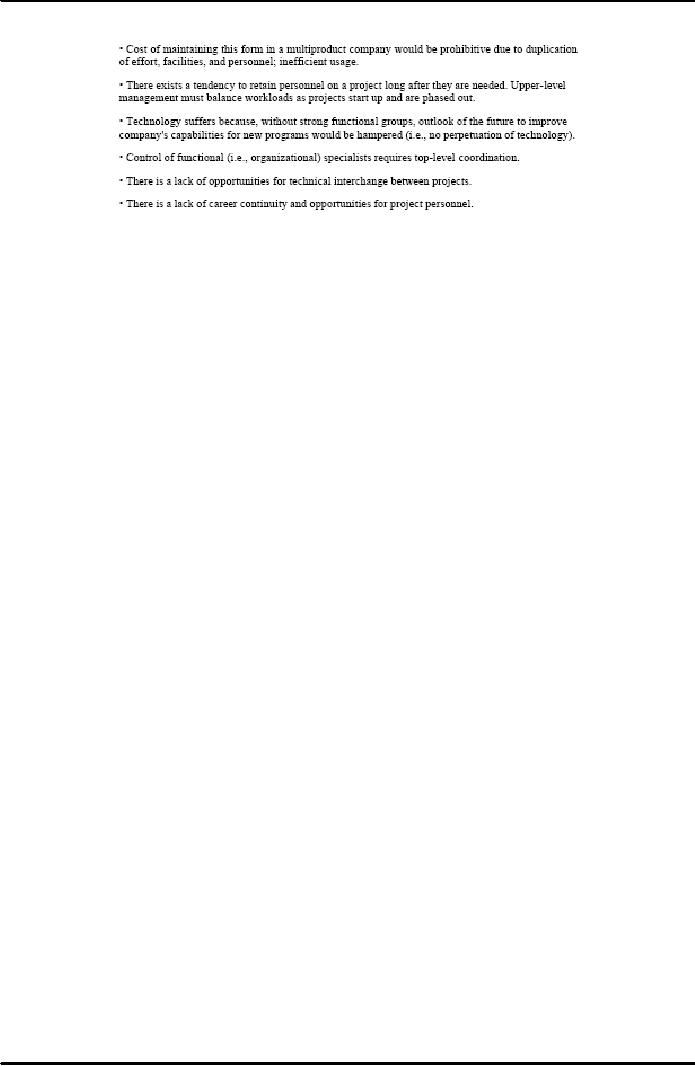

4.2: Disadvantages of
the traditional/classical
organization
30
Project
Management MGMT627
VU
4.8.2
LineStaff
Organization (Project
Coordinator):
It
soon became obvious that
control of a project must be
given to personnel whose
first
loyalty
is directed toward the completion of the
project. For this purpose, the
project
management
position must be separated
from any controlling
influence of the
functional
managers. Two possible situations
can exist with this
form of linestaff
project
control. In the first situation, the
project manager serves only
as the focal point
for
activity control, that is, a
center for information. The
prime responsibility of the
project
manager is to keep the division manager
informed of the status of the
project
and
to attempt to "influence" managers into
completing activities on
time.
The
amount of authority given to the project
manager posed serious problems.
Almost
all
upper level and division
managers were from the classical
management schools
and
therefore
maintained serious reservations about
how much authority to
relinquish.
Many
of these managers considered it a
demotion if they had to give up
any of their
long-established
powers.
4.8.3
Pure
Product (Projectized)
Organization:
The
pure product organization develops as a
division within a division. As
long as there
exists
a continuous flow of projects, work is
stable and conflicts are at a minimum.
The
major
advantage of this organizational flow is
that one individual, the
program
manager,
maintains complete line authority
over the entire project. Not
only does he
assign
work, but he also conducts
merit reviews. Because each
individual reports to
only
one person, strong communication
channels develop that result
in a very rapid
reaction
time.
In
pure product organizations,
long lead times became a
thing of the past.
Trade-off
studies
could be conducted as fast as time would
permit without the need to
look at the
impact
on other projects (unless, of course,
identical facilities or equipment
were
required).
Functional managers were able to
maintain qualified staffs for
new product
development
without sharing personnel with other
programs and projects.
The
responsibilities attributed to the
project manager were entirely
new. First of all,
his
authority
was now granted by the vice president and
general manager. The program
manager
handled all conflicts, both
those within his
organization and those
involving
other
projects. Interface management was
conducted at the program manager
level.
Upper-level
management was now able to
spend more time on executive
decision
making
than on conflict arbitration.
Advantages and disadvantages of
Projectized
organizations
are listed in tables 4.3 and
4.4 respectively.
31
Project
Management MGMT627
VU
Table

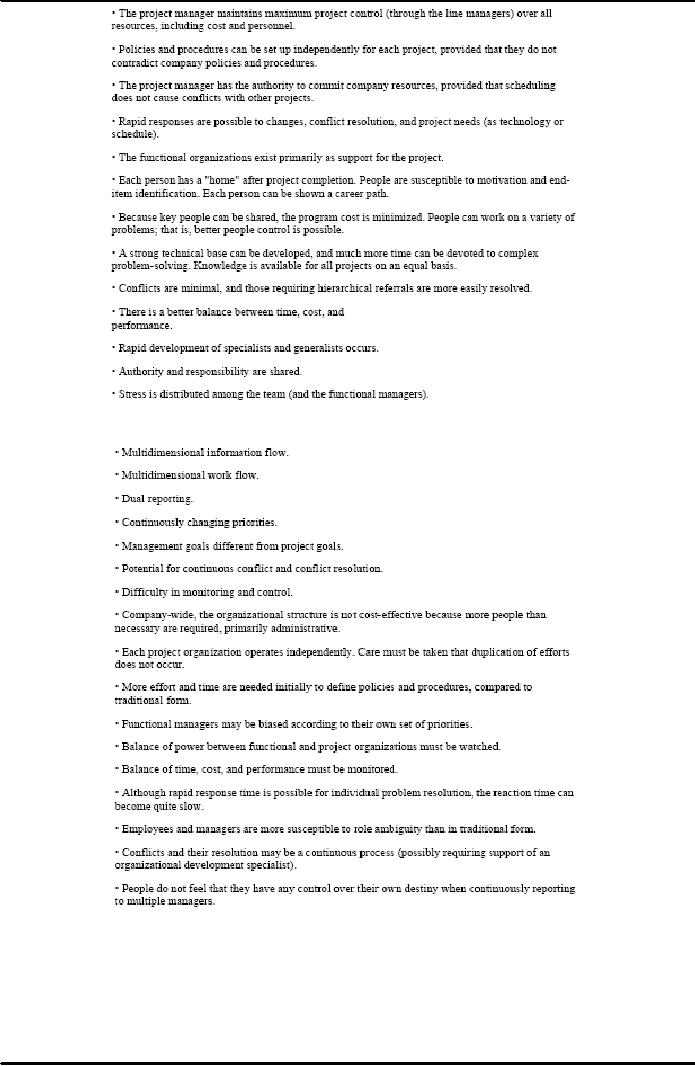

4.3: Advantages
of the Projectized organization
Table
4.4: Disadvantages of
the Projectized organization
4.8.4
Matrix
Organizational Form:
The
matrix organizational form is an attempt
to combine the advantages of the
pure
functional
structure and the product organizational structure.
This form is ideally
suited
for
companies, such as construction,
that are "project-driven."
Each project manager
reports
directly to the vice president and
general manager. Since each project
represents
a
potential profit center, the
power and authority used by the
project manager come
directly
from the general manager. The project
manager has total
responsibility and
accountability
for project success.
The
functional departments, on the other
hand, have functional responsibility
to
maintain
technical excellence on the project. Each
functional unit is headed by
a
department
manager whose prime
responsibility is to ensure that a
unified technical
base
is maintained and that all
available information can be exchanged
for each project.
Department
managers must also keep
their people aware of the latest
technical
accomplishments
in the industry.
Project
management is a "coordinative" function,
whereas matrix management is
a
collaborative
function division of project
management. In the coordinative or
project
organization,
work is generally assigned to
specific people or units who
"do their own
thing."
In the collaborative or matrix
organization, information sharing
may be
mandatory,
and several people may be
required for the same piece of
work. In a project
organization,
authority for decision
making and direction rests
with the project
leader,
whereas
in a matrix it rests with the
team.
Certain
ground rules exist for
matrix development. These
are:
·
Participants
must spend full time on the
project; this ensures a
degree of loyalty.
·
Horizontal
as well as vertical channels
must exist for making
commitments.
·
There
must be quick and effective
methods for conflict
resolution.
·
There
must be good communication
channels and free access between
managers.
·
All
managers must have input
into the planning
process.
·
Both
horizontally and vertically oriented
managers must be willing to
negotiate for
resources.
·
The
horizontal line must be
permitted to operate as a separate entity
except for
administrative
purposes.
These
ground rules simply state
some of the ideal conditions
that matrix
structures
should
possess. Each ground rule
brings with it advantages and
disadvantages that
are
described
in tables 4.5 and 4.6
respectively.
32
Project
Management MGMT627
VU
Table
4.5: Advantages
of the Matrix organization
Table
4.6: Disadvantages of
the Matrix organization
4.8.4.1
Modification of Matrix
Structures:
The
matrix structure can take
many forms, but there are
basically three common varieties.
Each
type
represents a different degree of
authority attributed to the program
manager and indirectly
identifies
the relative size of the company.
This type of arrangement works
best for small
33
Project
Management MGMT627
VU
companies
that have a minimum number of projects
and assume that the general
manager has
sufficient
time to coordinate activities between
his project managers. In
this type of
arrangement,
all conflicts between projects are
hierarchically referred to the general
manager for
resolution.
As
companies grew in size and the number of
projects, the general manager found
it
increasingly
difficult to act as the focal
point for all projects. A
new position was created,
that
of
director of programs, or manager of
programs or projects. The director of
programs was
responsible
for all program management.
This freed the general manager
from the daily
routine
of
having to monitor all programs
himself.
The
desired span of control, of course,
will vary from company to company
and must take the
following
into account:
·
The
demands imposed on the organization by
task complexity
·
Available
technology
·
The
external environment
·
The
needs of the organizational
membership
·
The
types of customers and/or products
These
variables influence the
internal functioning of the company.
Executives must realize
that
there
is no one best way to
organize under all
conditions. This includes the
span of control.
4.9
Selecting
the Organizational
Form:
Project
management has matured as an outgrowth of
the need to develop and produce
complex
and/or
large projects in the shortest possible
time, within anticipated
cost, with required
reliability
and performance, and (when applicable) to
realize a profit. Granted
that modern
organizations
have become so complex that
traditional organizational structures
and
relationships
no longer allow for
effective management, how
can executives determine
which
organizational
form is best, especially
since some projects last for
only a few weeks or
months
while
others may take
years?
To
answer such a question, we
must first determine whether
the necessary characteristics
exist
to
warrant a project management
organizational form. Generally speaking,
the project
management
approach can be effectively applied to a
one-time undertaking that
is:
·
Definable
in terms of a specific
goal
·
Infrequent,
unique, or unfamiliar to the present
organization
·
Complex
with respect to interdependence of
detailed tasks
·
Critical
to the company
Once
a group of tasks is selected and
considered to be a project, the next step
is to define the
kinds
of projects. These include individual,
staff, special, and matrix or aggregate
projects.
Unfortunately,
many companies do not have a clear
definition of what a project is. As a
result,
large
project teams are often
constructed for small projects when
they could be handled
more
quickly
and effectively by some
other structural
form.
34
Project
Management MGMT627
VU

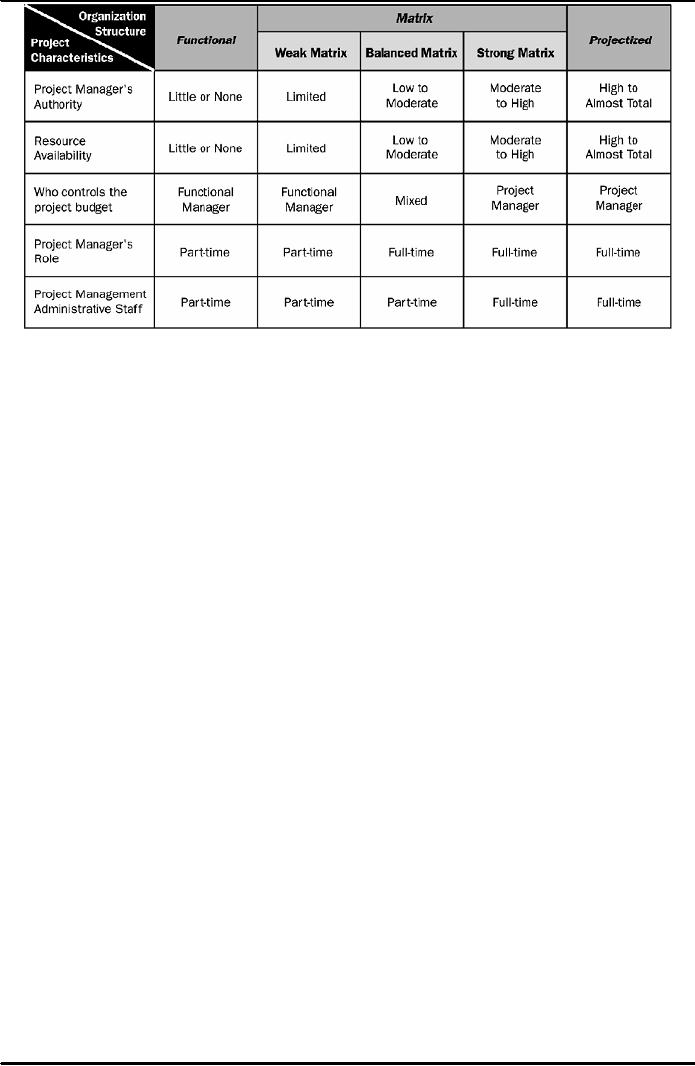

Figure
4.13: Project
Organizational Structure Influences on
Projects
All
structural forms have their advantages
and disadvantages, but the project
management
approach
appears to be the best possible
alternative.
The
basic factors that influence the
selection of a project organizational
form are:
·
Project
size
·
Project
length
·
Experience
with project management
organization
·
Philosophy
and visibility of upper-level
management
·
Project
location
·
Available
resources
·
Unique
aspects of the project
This
last item requires further comment.
Project management (especially
with a matrix)
usually
works
best for the control of human
resources and thus, may be more
applicable to labor-
intensive
projects rather than capital-intensive projects.
Labor-intensive organizations have
formal
project management, whereas
capital-intensive organizations may
use informal project
management.
Four
fundamental parameters must be
analyzed when considering
implementation of a project
organizational
form:
·
Integrating
devices
·
Authority
structure
·
Influence
distribution
·
Information
system
35
Table of Contents:
|
|||||
