NETWORK SCHEDULING TECHNIQUES
BROAD CONTENTS
Estimating Activity Time
Estimating Total Program Time
Total PERT/CPM Planning
Crash Times
PERT/CPM Problem Areas
Alternative PERT/CPM Model
30.1
Estimating Activity Time:
In order to determine the elapsed time between events requires that responsible functional
managers evaluate the situation and submit their best estimates. The calculations for critical
paths and slack times in the previous sections were based on these best estimates.
Thus, in this ideal situation, the functional manager would have at his disposal a large volume
of historical data from which to make his estimates. Obviously, the more historical data
available, the more reliable the estimate would be. Many programs, however, include events
and activities that are non-repetitive.
In this case, the functional managers must submit their estimates using three possible
completion assumptions:
·
Most optimistic completion time:
This time assumes that everything will go according to plan and with a minimal amount of
difficulties. This should occur approximately 1 percent of the time.
·
Most pessimistic completion time:
This time assumes that everything will not go according to plan and that the maximum
potential difficulties will develop. This should also occur approximately 1 percent of the
time.
·
Most likely completion time:
This is the time that, in the mind of the functional manager, would most often occur should
this effort be reported over and over again.
Two assumptions must be made before these three times can be combined into a single
expression for expected time. The first assumption is that the standard deviation,  , is one-sixth
of the time requirement range. This assumption stems from probability theory, where the end
points of a curve are three standard deviations from the mean. The second assumption requires
that the probability distribution of time required for an activity be expressible as a beta
distribution.

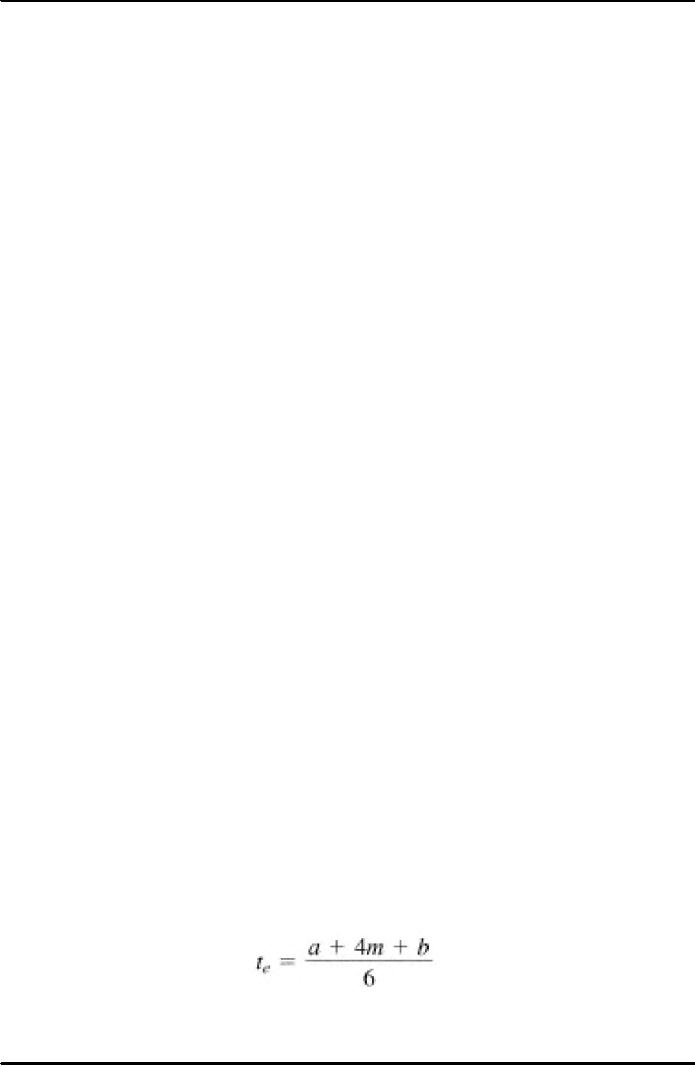

The expected time between events can be found from the expression:
In this, te = expected time, a = most optimistic time, b = most pessimistic time, and m = most
likely time.
213
Project Management ­MGMT627
VU
Here we take an example. If a = 3, b = 7, and m = 5 weeks, then the expected time, te, would be
5 weeks. This value for te would then be used as the activity time between two events in the
construction of a PERT chart. This method for obtaining best estimates contains a large degree
of uncertainty. If we change the variable times to a = 2, b = 12, and m = 4 weeks, then te will
still be 5 weeks. The latter case, however, has a much higher degree of uncertainty because of
the wider spread between the optimistic and pessimistic times. Care must be taken in the
evaluation of risks in the expected times.
30.2
Estimating Total Program Time:
It is important to know that in order to calculate the probability of completing the project on
time, the standard deviations of each activity must be known. This can be found from the
expression:
is the standard deviation of the expected time, te. Another useful expression is the
Where
variance,  , which is the square of the standard deviation. The variance is primarily useful for
comparison to the expected values.

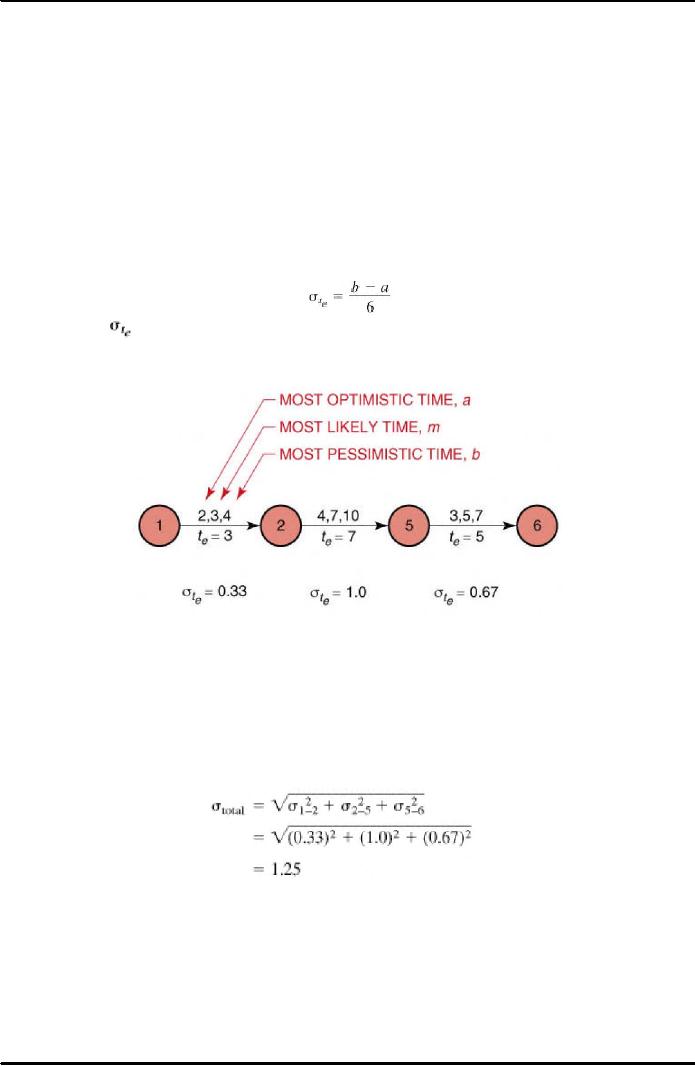

Figure 30.1: Expected Time Analysis for Critical Path Events in Figure 29.1 (Lecture 29)
However, the standard deviation can be used just as easily, except that we must identify whether
it is a one, two, or three sigma limit deviation. Figure 30.1 above shows the critical path of
Figure 29.1 (lecture 29), together with the corresponding values from which the expected times
were calculated, as well as the standard deviations. The total path standard deviation is
calculated by the square root of the sum of the squares of the activity standard deviations using
the following expression:
30.3
Total PERT/CPM Planning:
It is necessary to discuss the methodology for preparing PERT schedules, before we continue
further. PERT scheduling is a six-step process.
Steps one and two begin with the project manager laying out a list of activities to be performed
and then placing these activities in order of precedence, thus identifying the interrelationships.
These charts drawn by the project manager are called logic charts, arrow diagrams, work flow,
214
Project Management ­MGMT627
VU
or simply networks. The arrow diagrams will look like Figure 29.1 (lecture 29) with two
exceptions: The activity time is not identified, and neither is the critical path.
The next step that is step three is reviewing the arrow diagrams with the line managers (that is,
the true experts) in order to obtain their assurance that neither too many nor too few activities
are identified, and that the interrelationships are correct.
In step four, the functional manager converts the arrow diagram to a PERT chart by identifying
the time duration for each activity. It should be noted here that the time estimates that the line
managers provide are based on the assumption of unlimited resources because the calendar
dates have not yet been defined.
Fifth step is the first iteration on the critical path. It is here that the project manager looks at the
critical calendar dates in the definition of the project's requirements. If the critical path does not
satisfy the calendar requirements, then the project manager must try to shorten the critical path
using methods explained earlier or by asking the line managers to take the ''fat" out of their
estimates.
Step six is often the most overlooked step. Here the project manager places calendar dates on
each event in the PERT chart, thus, converting from planning under unlimited resources to
planning with limited resources. Even though the line manager has given you a time estimate,
there is no guarantee that the correct resources will be available when needed. That is why this
step is crucial. If the line manager cannot commit to the calendar dates, then replanning will be
necessary. Most companies that survive on competitive bidding lay out proposal schedules
based on unlimited resources. After contract award, the schedules are analyzed again because
the company now has limited resources.
The question arises that after all, how can a company bid on three contracts simultaneously and
put a detailed schedule into each proposal if it is not sure how many contracts, if any, it will
win? For this reason customers require that formal project plans and schedules be provided
thirty to ninety days after contract award.
Finally, PERT re-planning should be an ongoing function during project execution. The best
project managers are those individuals who continually try to assess what can go wrong and
perform perturbation analysis on the schedule. (This should be obvious because the constraints
and objectives of the project can change during execution.) Primary objectives on a schedule
are:
·
Best time
·
Least cost
·
Least risk
In addition to this, the secondary objectives include:
·
Studying alternatives
·
Optimum schedules
·
Effective use of resources
·
Communications
·
Refinement of the estimating process
·
Ease of project control
·
Ease of time or cost revisions
It is quite obvious that these objectives are limited by such constraints as:
·
Calendar completion
215
Project Management ­MGMT627
VU
·
Cash or cash flow restrictions
·
Limited resources
·
Management approvals
30.4
Crash Times:
So far no distinction was made between PERT and CPM. The basic difference between PERT
and CPM lies in the ability to calculate percent complete. PERT is used in Research and
Development or just development activities, where a percent-complete determination is almost
impossible.
Therefore, PERT is event oriented rather than activity oriented. In PERT, funding is normally
provided for each milestone (i.e., event) achieved because incremental funding along the
activity line has to be based on percent complete. CPM, on the other hand, is activity oriented
because, in activities such as construction, percent complete along the activity line can be
determined. CPM can be used as an arrow diagram network without PERT. The difference
between the two methods lies in the environments in which each one evolved and how each one
is applied.
In addition, the CPM (activity-type network) has been widely used in the process industries, in
construction, and in single-project industrial activities. Common problems include no place to
store early arrivals of raw materials and project delays for late arrivals.
Project managers can consider the cost of speeding up, or crashing, certain phases of a project
using strictly the CPM approach. In order to accomplish this, it is necessary to calculate a
crashing cost per unit time as well as the normal expected time for each activity. CPM charts,
which are closely related to PERT charts, allow visual representation of the effects of crashing.
There are these following requirements:
·
For a CPM chart, the emphasis is on activities, not events. Therefore, the PERT chart
should be redrawn with each circle representing an activity rather than an event.
·
In CPM, both time and cost of each activity are considered.
·
Only those activities on the critical path are considered, starting with the activities for which
the crashing cost per unit time is the lowest.
The following Figure 30.2 below shows a CPM network with the corresponding crash time for
all activities both on and off the critical path. The activities are represented by circles and
include an activity identification number and the estimated time. The costs expressed in it are
usually direct costs only.

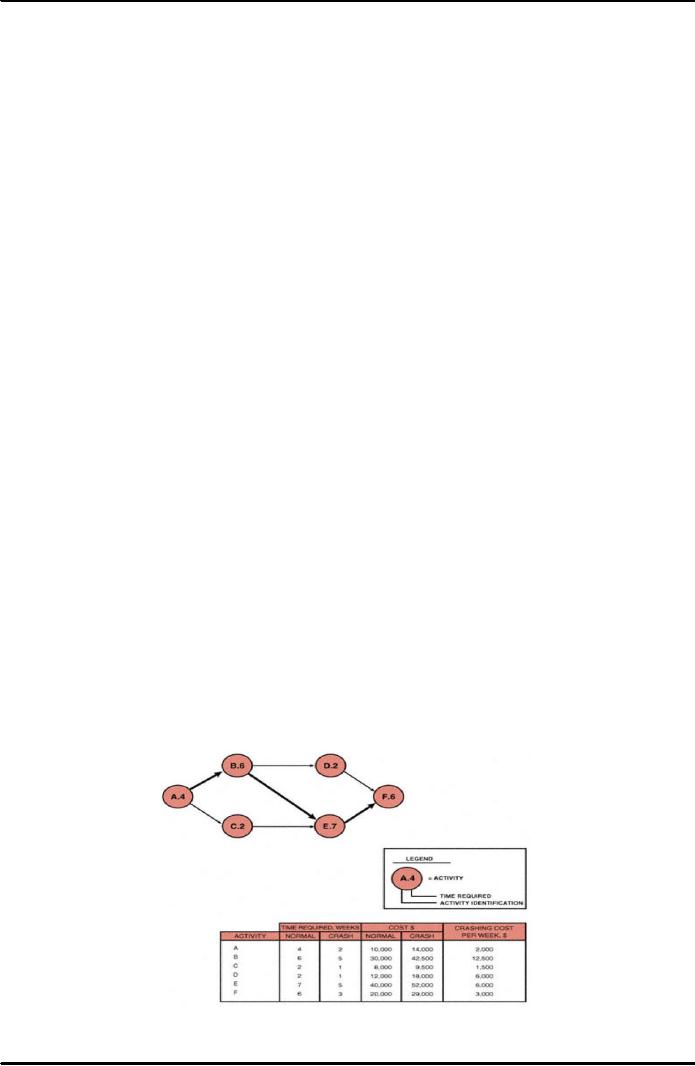

Figure 30.2: CPM Network
216
Project Management ­MGMT627
VU
As shown in the figure 30.2, in order to determine crashing costs we begin with the lowest
weekly crashing cost, activity A, at $2,000 per week. Although activity C has a lower crashing
cost, it is not on the critical path. Only critical path activities are considered for crashing.
Activity A will be the first to be crashed for a maximum of two weeks at $2,000 per week. The
next activity to be considered would be F at $3,000 per week for a maximum of three weeks.
These crashing costs are additional expenses above the normal estimates.
It is important to remember a word of caution concerning the selection and order of the
activities that are to crash: There is a good possibility that as each activity is crashed, a new
critical path will be developed. This new path may or may not include those elements that were
bypassed because they were not on the original critical path.
In the same Figure 30.2 (and assuming that no new critical paths are developed), activities A, F,
E, and B would be crashed in that order. The crashing cost would then be an increase of
$37,500 from the base of $120,000 to $157,500. The corresponding time would then be reduced
from twenty-three weeks to fifteen weeks. This is shown in Figure 30.3 below to illustrate how
a trade-off between time and cost can be obtained. Also shown in it is the increased cost of
crashing elements not on the critical path.

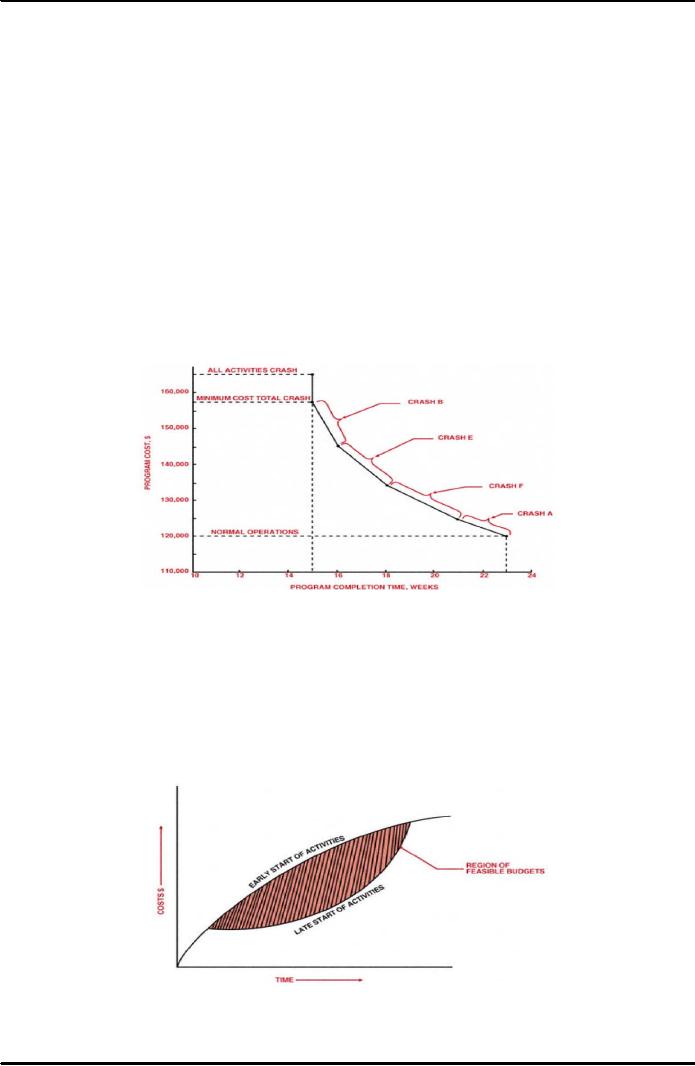

Figure 30.3: CPM Crashing Costs
Crashing these elements would result in a cost increase of $7,500 without reducing the total
project time. There is also the possibility that this figure will represent unrealistic conditions
because sufficient resources are not or cannot be made available for the crashing period.
Importantly, the purpose behind balancing time and cost is to avoid the useless waste of
resources. If the direct and indirect costs can be accurately obtained, then a region of feasible
budgets can be found, bounded by the early-start (crash) and late-start (or normal) activities.
This is shown in Figure 30.4 below.
Figure 30.4: Region of Feasible Budgets
217
Project Management ­MGMT627
VU
Since the direct and indirect costs are not necessarily expressible as linear functions, time­cost
trade-off relationships are made by searching for the lowest possible total cost (that is, direct
and indirect) that likewise satisfies the region of feasible budgets. This method is shown in
Figure 30.5 below.

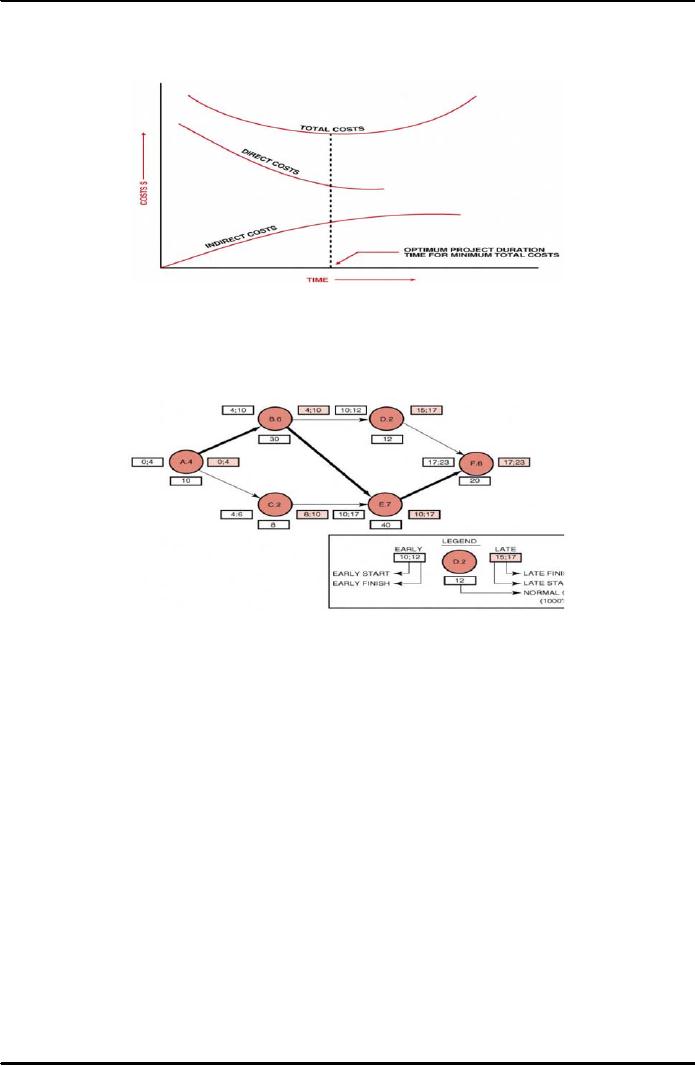

Figure 30.5: Determining Project Duration
Note that like PERT, CPM also contains the concept of slack time, the maximum amount of
time that a job may be delayed beyond its early start without delaying the project completion
time. Figure 30.6 below shows a typical representation of slack time using a CPM chart.
Figure 30.6: CPM Network with Slack
This figure also shows how target activity costs can be identified. It can be modified to include
normal and crash times as well as normal and crash costs. In this case, the cost box in the figure
would contain two numbers: The first number would be the normal cost, and the second would
be the crash cost. These numbers might also appear as running totals.
30.5
PERT/CPM Problem Areas:
Even the largest organizations with years of experience in using PERT and CPM have the same
ongoing problems as newer or smaller companies. Thus, PERT/CPM models are not without
their disadvantages and problems.
Due to its characteristics, many companies have a difficult time incorporating PERT systems
because PERT is end-item oriented. Many upper-level managers feel that the adoption of
PERT/CPM remove a good part of their power and ability to make decisions. This is
particularly evident in companies that have been forced to accept PERT/CPM as part of
contractual requirements.
In addition to this, there exists a distinct contrast in PERT systems between the planners and the
doers. This human element must be accounted for in order to determine where the obligation
actually lies. In most organizations PERT planning is performed by the program office and
functional management. Yet once the network is constructed, the planners and managers
become observers and rely on the doers to accomplish the job within time and cost limitations.
218
Project Management ­MGMT627
VU
Management must convince the doers that they have an obligation toward the successful
completion of the established PERT/CPM plans.
It is important to note that unless the project is repetitive, there usually exists a lack of historical
information on which to base the cost estimates of most optimistic, most pessimistic, and most
likely times. Problems can also involve poor predictions for overhead costs, other indirect costs,
material and labor escalation factors, and crash costs. It is also possible that each major
functional division of the organization has its own method for estimating costs. Engineering, for
example, may use historical data, whereas manufacturing operations may prefer learning curves.
PERT works best if all organizations have the same method for predicting costs and
performance.
PERT networks are based on the assumption that all activities start as soon as possible. This
assumes that qualified personnel and equipment are available. Regardless of how well we plan,
there almost always exist differences in performance times from what would normally be
acceptable for the model selected. For the selected model, time and cost should be well-
considered estimates, not a spur-of-the-moment decision.
Another problem is that of cost control. It presents a problem in that the project cost and control
system may not be compatible with company fiscal planning policies. Project-oriented costs
may be meshed with non-PERT-controlled jobs in order to develop the annual budget. This
becomes a difficult chore for cost reporting, especially when each project may have its own
method for analyzing and controlling costs.
Furthermore, many people have come to expect too much of PERT -type networks. Figure 30.7
below illustrates a PERT/CPM network broken down by work packages with identification of
the charge numbers for each activity. Large projects may contain hundreds of charge numbers.
Subdividing work packages (which are supposedly the lowest element) even further by
identifying all sub activities has the advantage that direct charge numbers can be easily
identified, but the time and cost for this form of detail may be prohibitive. PERT/CPM networks
are tools for program control, and managers must be careful that the original game plan of using
networks to identify prime and supporting objectives is still met. Additional detail may mask
this all-important purpose. Remember, networks are constructed as a means for understanding
program reports. Management should not be required to read reports in order to understand
PERT/CPM networks.

Figure 30.7: Using PERT for Work Package Control
30.6
Alternative PERT/CPM Models:
Numerous industries have found applications for this form of network, because of the many
advantages of PERT/time. A partial list of these advantages includes capabilities for:
219
Project Management ­MGMT627
VU
·
Trade-off studies for resource control
·
Providing contingency planning in the early stages of the project
·
Visually tracking up-to-date performance
·
Demonstrating integrated planning
·
Providing visibility down through the lowest levels of the work breakdown structure
·
Providing a regimented structure for control purposes to ensure compliance with the work
breakdown structure and the statement of work
·
Increasing functional members' ability to relate to the total program, thus, providing
participants with a sense of belonging
Remember that even with these advantages, in many situations PERT/time has proved
ineffective in controlling resources. Earlier we have defined three parameters necessary for the
control of resources: time, cost, and performance. With these factors in mind, companies began
reconstructing PERT/time into PERT/cost and PERT/performance models.
In addition, PERT/cost is an extension of PERT/time and attempts to overcome the problems
associated with the use of the most optimistic and most pessimistic time for estimating
completion. PERT/cost can be regarded as a cost accounting network model based on the work
breakdown structure and capable of being subdivided down to the lowest elements, or work
packages. The advantages of PERT/cost are that it:
·
Contains all the features of PERT/time
·
Permits cost control at any Work Breakdown Structure (WBS) level
Note that the primary reason for the development of PERT/cost was so that project managers
could identify critical schedule slippages and cost overruns in time for corrective action to be
taken.
In this regard, many attempts have been made to develop effective PERT/schedule models. In
almost all cases, the charts are constructed from left to right. An example of such current
attempts is the Accomplishment/Cost Procedure (ACP).
Summing up our discussion, unfortunately, the development of PERT/schedule techniques is
still in its infancy. Although their applications have been identified, many companies feel
locked in with their present method of control, whether it is PERT, CPM, or some other
technique.
220
Table of Contents:
  1. INTRODUCTION TO PROJECT MANAGEMENT:Broad Contents, Functions of Management
  2. CONCEPTS, DEFINITIONS AND NATURE OF PROJECTS:Why Projects are initiated?, Project Participants
  3. CONCEPTS OF PROJECT MANAGEMENT:THE PROJECT MANAGEMENT SYSTEM, Managerial Skills
  4. PROJECT MANAGEMENT METHODOLOGIES AND ORGANIZATIONAL STRUCTURES:Systems, Programs, and Projects
  5. PROJECT LIFE CYCLES:Conceptual Phase, Implementation Phase, Engineering Project
  6. THE PROJECT MANAGER:Team Building Skills, Conflict Resolution Skills, Organizing
  7. THE PROJECT MANAGER (CONTD.):Project Champions, Project Authority Breakdown
  8. PROJECT CONCEPTION AND PROJECT FEASIBILITY:Feasibility Analysis
  9. PROJECT FEASIBILITY (CONTD.):Scope of Feasibility Analysis, Project Impacts
  10. PROJECT FEASIBILITY (CONTD.):Operations and Production, Sales and Marketing
  11. PROJECT SELECTION:Modeling, The Operating Necessity, The Competitive Necessity
  12. PROJECT SELECTION (CONTD.):Payback Period, Internal Rate of Return (IRR)
  13. PROJECT PROPOSAL:Preparation for Future Proposal, Proposal Effort
  14. PROJECT PROPOSAL (CONTD.):Background on the Opportunity, Costs, Resources Required
  15. PROJECT PLANNING:Planning of Execution, Operations, Installation and Use
  16. PROJECT PLANNING (CONTD.):Outside Clients, Quality Control Planning
  17. PROJECT PLANNING (CONTD.):Elements of a Project Plan, Potential Problems
  18. PROJECT PLANNING (CONTD.):Sorting Out Project, Project Mission, Categories of Planning
  19. PROJECT PLANNING (CONTD.):Identifying Strategic Project Variables, Competitive Resources
  20. PROJECT PLANNING (CONTD.):Responsibilities of Key Players, Line manager will define
  21. PROJECT PLANNING (CONTD.):The Statement of Work (Sow)
  22. WORK BREAKDOWN STRUCTURE:Characteristics of Work Package
  23. WORK BREAKDOWN STRUCTURE:Why Do Plans Fail?
  24. SCHEDULES AND CHARTS:Master Production Scheduling, Program Plan
  25. TOTAL PROJECT PLANNING:Management Control, Project Fast-Tracking
  26. PROJECT SCOPE MANAGEMENT:Why is Scope Important?, Scope Management Plan
  27. PROJECT SCOPE MANAGEMENT:Project Scope Definition, Scope Change Control
  28. NETWORK SCHEDULING TECHNIQUES:Historical Evolution of Networks, Dummy Activities
  29. NETWORK SCHEDULING TECHNIQUES:Slack Time Calculation, Network Re-planning
  30. NETWORK SCHEDULING TECHNIQUES:Total PERT/CPM Planning, PERT/CPM Problem Areas
  31. PRICING AND ESTIMATION:GLOBAL PRICING STRATEGIES, TYPES OF ESTIMATES
  32. PRICING AND ESTIMATION (CONTD.):LABOR DISTRIBUTIONS, OVERHEAD RATES
  33. PRICING AND ESTIMATION (CONTD.):MATERIALS/SUPPORT COSTS, PRICING OUT THE WORK
  34. QUALITY IN PROJECT MANAGEMENT:Value-Based Perspective, Customer-Driven Quality
  35. QUALITY IN PROJECT MANAGEMENT (CONTD.):Total Quality Management
  36. PRINCIPLES OF TOTAL QUALITY:EMPOWERMENT, COST OF QUALITY
  37. CUSTOMER FOCUSED PROJECT MANAGEMENT:Threshold Attributes
  38. QUALITY IMPROVEMENT TOOLS:Data Tables, Identify the problem, Random method
  39. PROJECT EFFECTIVENESS THROUGH ENHANCED PRODUCTIVITY:Messages of Productivity, Productivity Improvement
  40. COST MANAGEMENT AND CONTROL IN PROJECTS:Project benefits, Understanding Control
  41. COST MANAGEMENT AND CONTROL IN PROJECTS:Variance, Depreciation
  42. PROJECT MANAGEMENT THROUGH LEADERSHIP:The Tasks of Leadership, The Job of a Leader
  43. COMMUNICATION IN THE PROJECT MANAGEMENT:Cost of Correspondence, CHANNEL
  44. PROJECT RISK MANAGEMENT:Components of Risk, Categories of Risk, Risk Planning
  45. PROJECT PROCUREMENT, CONTRACT MANAGEMENT, AND ETHICS IN PROJECT MANAGEMENT:Procurement Cycles
