LESSON 29
NETWORK SCHEDULING TECHNIQUES
BROAD CONTENTS
Slack Terminology
Slack Time Calculation
Slack Identification
Network Re-planning
29.1
Slack Terminology:
Slack can be defined as the difference between the latest allowable date and the earliest
expected data based on the nomenclature below:
TE = the earliest time (date) on which an event can be expected to take place
TL = the latest date on which an event can take place without extending the completion date of
the project
Slack time = TL ­ TE
29.2
Slack Time Calculation:
As shown in Figure 29.1 below, the calculation for slack time is performed for each event in the
network, by identifying the earliest expected date and the latest starting date. For event 1, TL ­
TE = 0. Event 1 serves as the reference point for the network and could just as easily have been
defined as a calendar date. As before, the critical path is represented as a bold line. The events
on the critical path have no slack (i.e., TL = TE) and provide the boundaries for the non-critical
path events. Since event 2 is critical, TL = TE × 3 + 7 = 10 for event 5. Event 6 terminates the
critical path with a completion time of fifteen weeks.
The earliest time for event 3, which is not on the critical path, would be two weeks (TE = 0 + 2
= 2), assuming that it started as early as possible. The latest allowable date is obtained by
subtracting the time required to complete the activity from events 3 to 5 from the latest starting
date of event 5.

Figure 29.1: PERT Network with Slack Time
Therefore, TL (for event 3) = 10 ­ 5 = 5 weeks. Event 3 can now occur anywhere between
weeks 2 and 5 without interfering with the scheduled completion date of the project. This same
procedure can be applied to event 4, in which case TE = 6 and TL = 9.
205
Project Management ­MGMT627
VU
The same figure 29.1 contains a simple PERT network, and therefore the calculation of slack
time is not too difficult. For complex networks containing multiple paths, the earliest starting
dates must be found by proceeding from start to finish through the network, while the latest
allowable starting date must be calculated by working backward from finish to start.

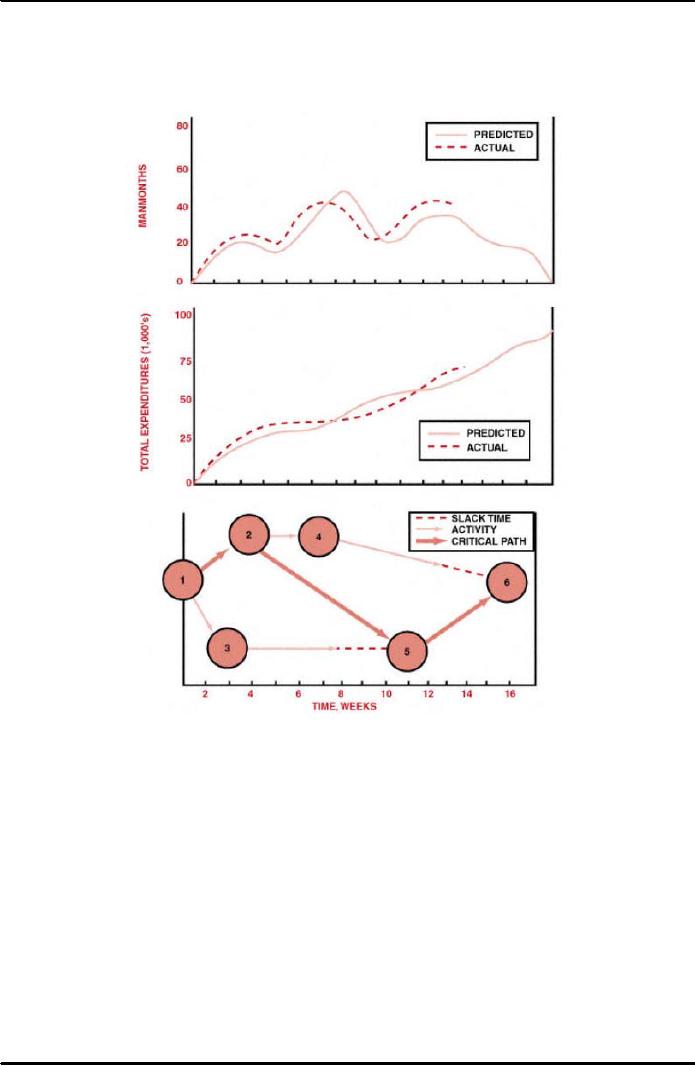

Figure 29.2: Comparison Models for a Time- Phase PERT Chart
We must understand that the importance of knowing exactly where the slack exists cannot be
overstated. Proper use of slack time permits better technical performance. Donald Marquis has
observed that those companies making proper use of slack time were 30 percent more
successful than the average in completing technical requirements.
PERT networks are often not plotted with a time scale, because of these slack times. Planning
requirements, however, can require that PERT charts be reconstructed with time scales, in
which case a decision must be made as to whether we wish early or late time requirements for
slack variables. This is shown in Figure 29.2 above for comparison with total program costs and
manpower planning. Early time requirements for slack variables are utilized in this figure.
Note that the earliest times and late times can be combined to determine the probability of
successfully meeting the schedule. A sample of the required information is shown in Table 29.1
below. The earliest and latest times are considered as random variables. The original schedule
refers to the schedule for event occurrences that were established at the beginning of the project.
206
Project Management ­MGMT627
VU
The last column in this table gives the probability that the earliest time will not be greater than
the original schedule time for this event.
Table 29.1: PERT Control Output Information
In the example shown in Figure 29.1, the earliest and latest times were calculated for each
event. Some people prefer to calculate the earliest and latest times for each activity instead.
Also, the earliest and latest times were identified simply as the time or date when an event can
be expected to take place. To make full use of the capabilities of PERT/CPM, we could identify
the following four values:
·
The earliest time when an activity can start (ES)
·
The earliest time when an activity can finish (EF)
·
The latest time when an activity can start (LS)
·
The latest time when an activity can finish (LF)
The following Figure 29.3 below shows the earliest and latest times identified on the activity.
In order to calculate the earliest starting times, we must make a forward pass through the
network (that is, left to right). The earliest starting time of a successor activity is the latest of the
earliest finish dates of the predecessors. The latest starting time is the total of the earliest
starting time and the activity duration.

Figure 29.3: Slack Identification
It is important to note that to calculate the finishing times we must make a backward pass
through the network by calculating the latest finish time. Since the activity time is known, the
latest starting time can be calculated by subtracting the activity time from the latest finishing
time. The latest finishing time for an activity entering a node is the earliest finishing time of the
activities exiting the node.
Figure 29.4 below shows the earliest and latest starting and finishing times for a typical
network.
Figure 29.4: A Typical PERT Chart with Slack Times
207
Project Management ­MGMT627
VU
29.3
Slack Identification:
Its significance is that the identification of slack time can function as an early warning system
for the project manager. As an example, if the total slack time available begins to decrease from
one reporting period to the next, that could indicate that work is taking longer than anticipated
or that more highly skilled labor is needed. A new critical path could be forming.
By looking at the earliest and latest start and finish times, we can identify slack. As an example,
look at the two situations below:
According to these, in Situation a, the slack is easily identified as four work units, where the
work units can be expressed in hours, days, weeks, or even months. In Situation b, the slack is
negative five units of work. This is referred to as negative slack or negative float.
Here the question arises, what can cause the slack to be negative? Look at Figure 29.5 below.
When performing a forward pass through a network, we work from left to right beginning at the
customer's starting milestone (position 1). The backward pass, however, begins at the
customer's end date milestone (position 2), not (as is often taught in the classroom) where the
forward pass ends. If the forward pass ends at position 3, which is before the customer's end
date, it is possible to have slack on the critical path.

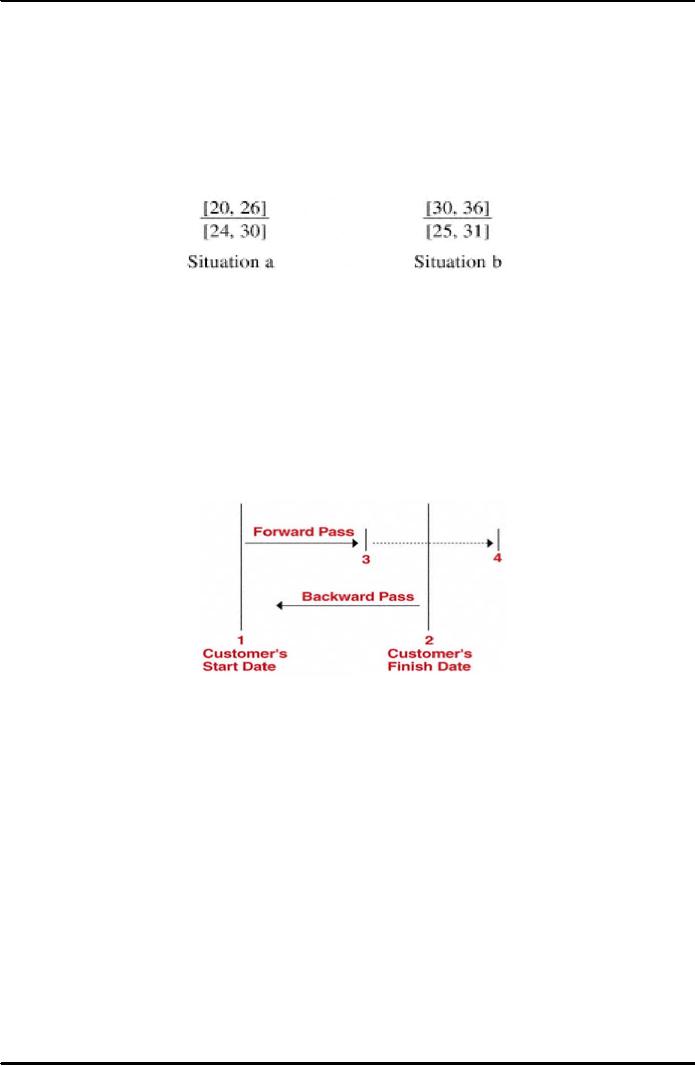

Figure 29.5: Slack Time
This slack is often called reserve time and may be added to other activities or filled with
activities such as report writing so that the forward pass will extend to the customer's
completion date.
Note that negative slack usually occurs when the forward pass extends beyond the customer's
end date, as shown by position 4 in the figure. However, the backward pass is still measured
from the customer's completion date, thus creating negative slack. This is most likely to result
when:
·
The original plan was highly optimistic, but unrealistic
·
The customer's end date was unrealistic
·
One or more activities slipped during project execution
·
The assigned resources did not possess the correct skill levels
·
The required resources would not be available until a later date
In any event, negative slack is an early warning indicator that corrective action is needed to
maintain the customer's end date.
208
Project Management ­MGMT627
VU
29.4
Network Re-planning:
We know that once constructed, the PERT/CPM charts provide the framework from which
detailed planning can be initiated and costs can be controlled and tracked. Much iteration,
however, are normally made during the planning phase before the PERT/CPM chart is finished.

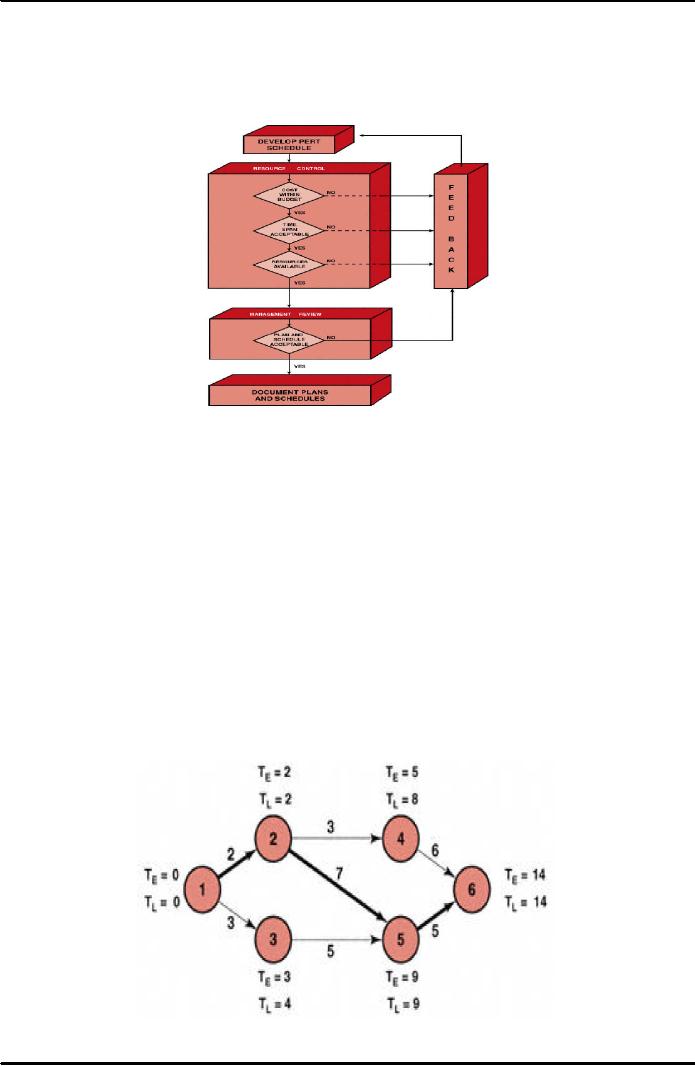

Figure 29.6: Iteration Process for PERT Schedule Development
This iteration process is shown in the Figure 29.6 above. The slack times form the basis from
which additional iterations, or network replanning, can be performed. Network replanning is
performed either at the conception of the program in order to reduce the length of the critical
path, or during the program, should the unexpected occur. If all were to go according to
schedule, then the original PERT/CPM chart would be unchanged for the duration of the
project. But, how many programs or projects follow an exact schedule from start to finish?
Let us again consider Figure 29.1. Suppose that activities 1­2 and 1­3 in it require manpower
from the same functional unit. Upon inquiry by the project manager, the functional manager
asserts that he can reduce activity 1­2 by one week if he shifts resources from activity 1­3 to
activity 1­2. Should this happen, however, activity 1­3 will increase in length by one week.

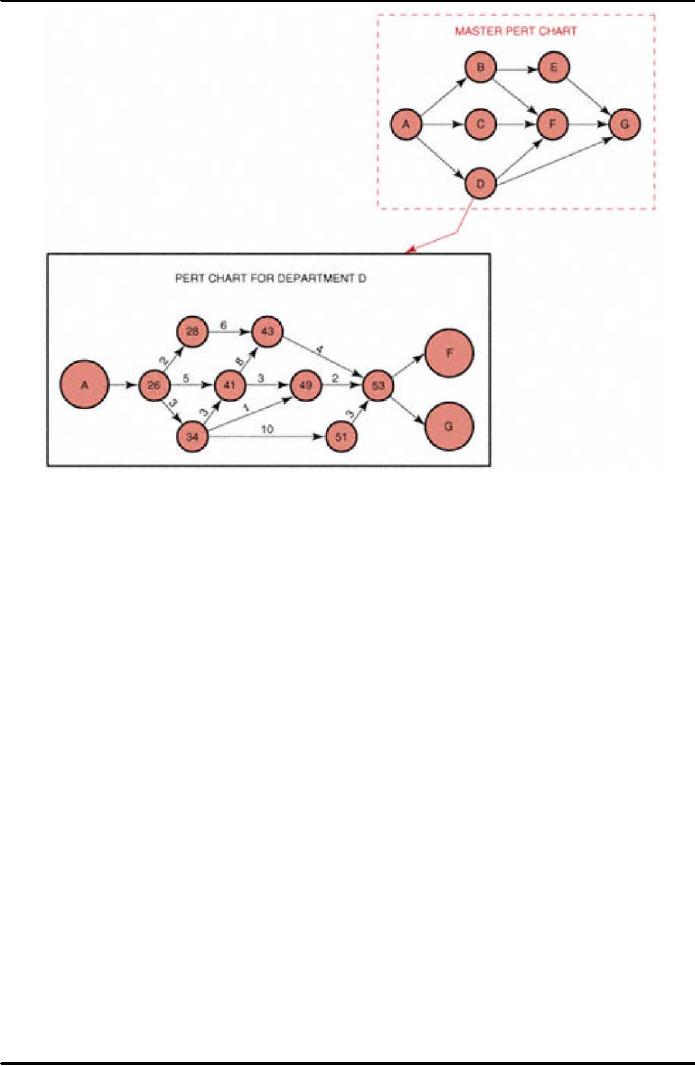

Reconstructing the PERT/CPM network as shown in Figure 29.7 below, the length of the
critical path is reduced by one week, and the corresponding slack events are likewise changed.
Figure 29.7: Network Replanning of Figure 29.1
209
Project Management ­MGMT627
VU
29.4.1 Network Replanning Techniques:
There are two network replanning techniques based almost entirely upon resources:
resource leveling and resource allocation.
·
Resource leveling is an attempt to eliminate the manpower peaks and valleys by
smoothing out the period-to-period resource requirements. The ideal situation is to
do this without changing the end date. However, in reality, the end date moves out
and additional costs are incurred.
·
Resource allocation is an attempt to find the shortest possible critical path based
upon the available or fixed resources. The problem with this approach is that the
employees may not be qualified technically to perform on more than one activity in
a network.
Not all PERT/CPM networks permit such easy rescheduling of resources. Project
managers should make every attempt to reallocate resources so as to reduce the critical
path, provided that the slack was not intentionally planned as a safety valve.
It is important to note here that transferring resources from slack paths to more critical
paths is only one method for reducing expected project time. Several other methods are
available. These are as follows:
·
Elimination of some parts of the project
·
Addition of more resources
·
Substitution of less time-consuming components or activities
·
Parallelization of activities
·
Shortening critical path activities
·
Shortening early activities
·
Shortening longest activities
·
Shortening easiest activities
·
Shortening activities that are least costly to speed up
·
Shortening activities for which you have more resources
·
Increasing the number of work hours per day
In this regard, under the ideal situation, the project start and end dates are fixed, and
performance within this time scale must be completed within the guidelines described
by the statement of work. Should the scope of effort have to be reduced in order to meet
other requirements, the contractor incurs a serious risk in that the project may be
canceled, or performance expectations may no longer be possible.
However, adding resources is not always possible. If the activities requiring these added
resources also call for certain expertise, then the contractor may not have qualified or
experienced employees, and may avoid the risk. The contractor might still reject this
idea, even if time and money were available for training new employees, because on
project termination he might not have any other projects to which to assign these
additional people. However, if the project is the construction of a new facility, then the
labor-union pool may be large enough that additional experienced manpower can be
hired.
Another aspect is parallelization of activities. It can be regarded as accepting a risk by
assuming that a certain event can begin in parallel with a second event that would
normally be in sequence with it. This is shown in Figure 29.8 below. One of the biggest
headaches at the beginning of any project is the purchasing of tooling and raw

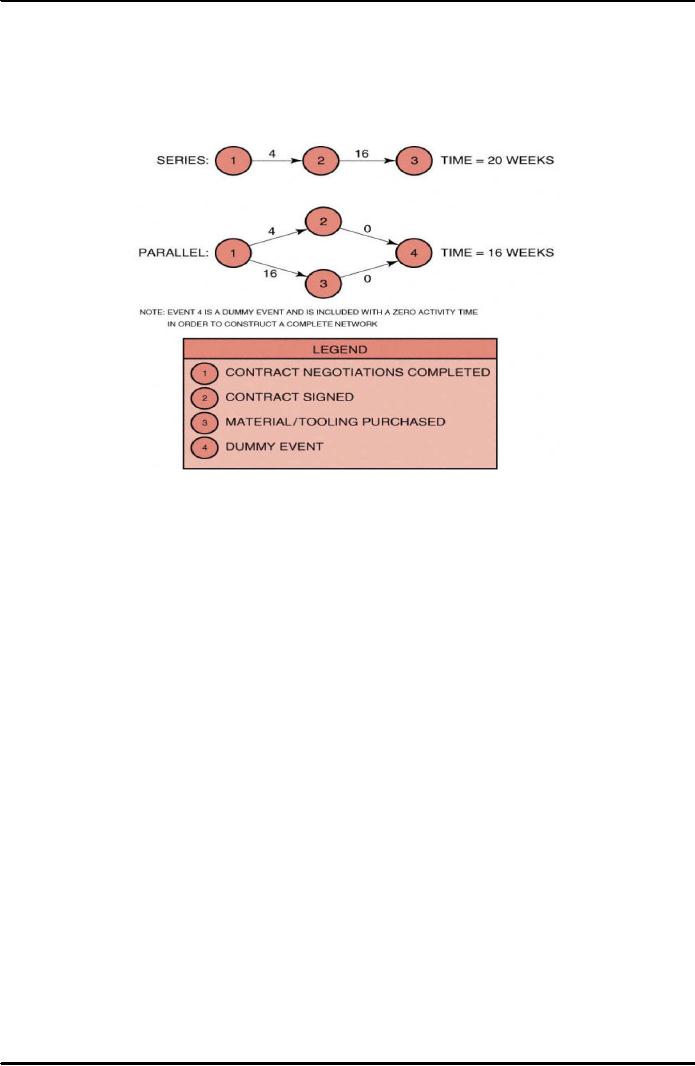

materials. As shown in Figure below, four weeks can be saved by sending out purchase
210
Project Management ­MGMT627
VU
orders after contract negotiations are completed, but before the one-month waiting
period necessary to sign the contract. Here the contractor incurs a risk. Should the effort
be canceled or the statement of work change prior to the signing of the contract, the
customer incurs the cost of the termination liability expenses from the vendors. This
risk is normally overcome by the issuance of a long-lead procurement letter
immediately following contract negotiations.
Figure 29.8: Parallelization of PERT Activities
In addition to this, there are two other types of risk that are common. In the first
situation, engineering has not yet finished the prototype, and manufacturing must order
the tooling in order to keep the end date fixed. In this case, engineering may finally
design the prototype to fit the tooling.
In the second situation, the subcontractor finds it difficult to perform according to the
original blueprints. In order to save time, the customer may allow the contractor to work
without blueprints, and the blueprints are then changed to represent the as-built end-
item.
As a result of the complexities of large programs, network re-planning becomes an
almost impossible task when analyzed on total program activities. It is often better to
have each department or division that develops its own PERT/CPM networks, on
approval by the project office, and based on the work breakdown structure. The
individual PERT charts are then integrated into one master chart to identify total
program critical paths, as shown in Figure 29.9 below. It should not be inferred from
this figure that department D does not interact with other departments or that
department D is the only participant for this element of the project.
In addition, segmented PERT charts can also be used when a number of contractors
work on the same program.
Each contractor (or subcontractor) develops his own PERT chart. It then becomes the
responsibility of the prime contractor to integrate all of the subcontractors' PERT charts
to ensure that total program requirements can be met.
211
Project Management ­MGMT627
VU
Figure 29.9: Master PERT chart breakdown by department
212
Table of Contents:
  1. INTRODUCTION TO PROJECT MANAGEMENT:Broad Contents, Functions of Management
  2. CONCEPTS, DEFINITIONS AND NATURE OF PROJECTS:Why Projects are initiated?, Project Participants
  3. CONCEPTS OF PROJECT MANAGEMENT:THE PROJECT MANAGEMENT SYSTEM, Managerial Skills
  4. PROJECT MANAGEMENT METHODOLOGIES AND ORGANIZATIONAL STRUCTURES:Systems, Programs, and Projects
  5. PROJECT LIFE CYCLES:Conceptual Phase, Implementation Phase, Engineering Project
  6. THE PROJECT MANAGER:Team Building Skills, Conflict Resolution Skills, Organizing
  7. THE PROJECT MANAGER (CONTD.):Project Champions, Project Authority Breakdown
  8. PROJECT CONCEPTION AND PROJECT FEASIBILITY:Feasibility Analysis
  9. PROJECT FEASIBILITY (CONTD.):Scope of Feasibility Analysis, Project Impacts
  10. PROJECT FEASIBILITY (CONTD.):Operations and Production, Sales and Marketing
  11. PROJECT SELECTION:Modeling, The Operating Necessity, The Competitive Necessity
  12. PROJECT SELECTION (CONTD.):Payback Period, Internal Rate of Return (IRR)
  13. PROJECT PROPOSAL:Preparation for Future Proposal, Proposal Effort
  14. PROJECT PROPOSAL (CONTD.):Background on the Opportunity, Costs, Resources Required
  15. PROJECT PLANNING:Planning of Execution, Operations, Installation and Use
  16. PROJECT PLANNING (CONTD.):Outside Clients, Quality Control Planning
  17. PROJECT PLANNING (CONTD.):Elements of a Project Plan, Potential Problems
  18. PROJECT PLANNING (CONTD.):Sorting Out Project, Project Mission, Categories of Planning
  19. PROJECT PLANNING (CONTD.):Identifying Strategic Project Variables, Competitive Resources
  20. PROJECT PLANNING (CONTD.):Responsibilities of Key Players, Line manager will define
  21. PROJECT PLANNING (CONTD.):The Statement of Work (Sow)
  22. WORK BREAKDOWN STRUCTURE:Characteristics of Work Package
  23. WORK BREAKDOWN STRUCTURE:Why Do Plans Fail?
  24. SCHEDULES AND CHARTS:Master Production Scheduling, Program Plan
  25. TOTAL PROJECT PLANNING:Management Control, Project Fast-Tracking
  26. PROJECT SCOPE MANAGEMENT:Why is Scope Important?, Scope Management Plan
  27. PROJECT SCOPE MANAGEMENT:Project Scope Definition, Scope Change Control
  28. NETWORK SCHEDULING TECHNIQUES:Historical Evolution of Networks, Dummy Activities
  29. NETWORK SCHEDULING TECHNIQUES:Slack Time Calculation, Network Re-planning
  30. NETWORK SCHEDULING TECHNIQUES:Total PERT/CPM Planning, PERT/CPM Problem Areas
  31. PRICING AND ESTIMATION:GLOBAL PRICING STRATEGIES, TYPES OF ESTIMATES
  32. PRICING AND ESTIMATION (CONTD.):LABOR DISTRIBUTIONS, OVERHEAD RATES
  33. PRICING AND ESTIMATION (CONTD.):MATERIALS/SUPPORT COSTS, PRICING OUT THE WORK
  34. QUALITY IN PROJECT MANAGEMENT:Value-Based Perspective, Customer-Driven Quality
  35. QUALITY IN PROJECT MANAGEMENT (CONTD.):Total Quality Management
  36. PRINCIPLES OF TOTAL QUALITY:EMPOWERMENT, COST OF QUALITY
  37. CUSTOMER FOCUSED PROJECT MANAGEMENT:Threshold Attributes
  38. QUALITY IMPROVEMENT TOOLS:Data Tables, Identify the problem, Random method
  39. PROJECT EFFECTIVENESS THROUGH ENHANCED PRODUCTIVITY:Messages of Productivity, Productivity Improvement
  40. COST MANAGEMENT AND CONTROL IN PROJECTS:Project benefits, Understanding Control
  41. COST MANAGEMENT AND CONTROL IN PROJECTS:Variance, Depreciation
  42. PROJECT MANAGEMENT THROUGH LEADERSHIP:The Tasks of Leadership, The Job of a Leader
  43. COMMUNICATION IN THE PROJECT MANAGEMENT:Cost of Correspondence, CHANNEL
  44. PROJECT RISK MANAGEMENT:Components of Risk, Categories of Risk, Risk Planning
  45. PROJECT PROCUREMENT, CONTRACT MANAGEMENT, AND ETHICS IN PROJECT MANAGEMENT:Procurement Cycles
