SCHEDULES AND CHARTS
BROAD CONTENTS
Detailed Schedules and Charts
Guidelines for Preparation of Schedules
Preparation Sequence of Schedules
Master Production Scheduling
Definition of Master Production Schedule (MPS)
Objectives of Master Production Schedule (MPS)
Program Plan
24.1
Detailed Schedules and Charts:
The first major requirement of the program office after the program goes ahead is the
scheduling of activities.
If the activity is not too complex, the program office normally assumes full responsibility for
activity scheduling. For large programs, functional management input is required before
scheduling can be completed.
Depending on program size and contractual requirements, it is not unusual for the program
office to maintain, at all times, a program staff member whose responsibility is that of a
scheduler. This individual continuously develops and updates activity schedules to provide a
means of tracking program work. The resulting information is then supplied to the program
office personnel, functional management, and team members, and, last but not least, is
presented to the customer.
Note that the activity scheduling is probably the single most important tool for determining how
company resources should be integrated so that synergy is produced. Activity schedules are
invaluable for projecting time-phased resource utilization requirements as well as providing a
basis for visually tracking performance.
In many cases, most programs begin with the development of schedules so that accurate cost
estimates can be made. The schedules serve as master plans from which both the customer and
management have an up-to-date picture of operations.
24.2
Guidelines for Preparation of Schedules:
Regardless of the projected use or complexity, certain guidelines should be followed in the
preparation of schedules. These are as follows:
·
Firstly, all major events and dates must be clearly identified. If the customer supplies a
statement of work, those dates shown on the accompanying schedules must be included. If
for any reason the customer's milestone dates cannot be met, the customer should be
notified immediately.
·
The exact sequence of work should be defined through a network in which
interrelationships between events can be identified.
·
Schedules should be directly relatable to the Work Breakdown Structure (WBS). If the
Work Breakdown Structure (WBS) is developed according to a specific sequence of work,
then it becomes an easy task to identify work sequences in schedules using the same
163
Project Management ­MGMT627
VU
numbering system as in the Work Breakdown Structure (WBS). The minimum requirement
should be to show where and when all tasks start and finish.
·
All schedules must identify the time constraints and, if possible, should identify those
resources required for each event.
Here we see that although these four guidelines relate to schedule preparation, they do not
define how complex the schedules should be. Before preparing schedules, three questions
should be considered:
·
How many events or activities should each network have?
·
How much of a detailed technical breakdown should be included?
·
Who is the intended audience for this schedule?
In this regard, most organizations develop multiple schedules: summary schedules for management
and planners and detailed schedules for the doers and lower-level control. The detailed schedules
may be strictly for interdepartmental activities. Program management must approve all schedules
down through the first three levels of the work breakdown structure. For lower-level schedules (that
is, detailed interdepartmental), program management may or may not request a sign of approval.
The need for two schedules is clear. In larger complicated projects, planning and status review
by different echelons are facilitated by the use of detailed and summary networks. Higher levels
of management can view the entire project and the interrelationships of major tasks without
looking into the detail of the individual subtasks. Lower levels of management and supervision
can examine their parts of the project in fine detail without being distracted by those parts of the
project with which they have no interface.
One of the most difficult problems to identify in schedules is a hedge position. A hedge position
is a situation in which the contractor may not be able to meet a customer's milestone date
without incurring a risk, or may not be able to meet activity requirements following a milestone
date because of contractual requirements.
24.3
Preparation Sequence of Schedules:
For almost every activity detailed schedules are prepared. It is the responsibility of the program
office to marry all of the detailed schedules into one master schedule to verify that all activities
can be completed as planned.
According to the sequence, the program office submits a request for detailed schedules to the
functional managers then prepare summary schedules, detailed schedules, and, if time permits,
interdepartmental schedules. Each functional manager then reviews his schedules with the
program office. The program office, together with the functional program team members,
integrates all of the plans and schedules and verifies that all contractual dates can be met.
Note that before the schedules are submitted to publications, rough drafts of each schedule and
plan should be reviewed with the customer. This procedure accomplishes the following:
·
Verifies that nothing has fallen through the cracks
·
Prevents immediate revisions to a published document and can prevent embarrassing
moments
·
Minimizes production costs by reducing the number of early revisions
·
Shows customers early in the program that you welcome their help and input into the
planning phase
Once the document is published, it should be distributed to all program office personnel,
functional team members, functional management, and the customer.
164
Project Management ­MGMT627
VU
The exact method of preparing the schedules is usually up to the individual performing the
activity.
However, the program office must approve all schedules. The schedules are normally prepared
in a format that is suitable to both the customer and contractor and is easily understood by all.
The schedules may then be used in-house as well as for customer review meetings, in which
case the contractor can "kill two birds with one stone" by tracking cost and performance on the
original schedules.
In addition to the detailed schedules, the program office, with input provided by functional
management, must develop organization charts. The organizational charts tell all active
participants in the project who has responsibility for each activity. The organizational charts
display the formal (and often the informal) lines of communication.
Linear responsibility charts (LRCs) are also established by the program office. In spite of the
best attempts by management, many functions in an organization may overlap between
functional units.
The management might also wish to have the responsibility for a certain activity given to a
functional unit that normally would not have that responsibility. This is a common occurrence
on short duration programs where management desires to cut costs and red tape.
Importantly, care must be taken that project personnel do not forget the reason why the schedule
was developed.
Summing this up, the primary objective of detailed schedules is usually to coordinate activities
into a master plan in order to complete the project with the:
·
Best time
·
Least cost
·
Least risk
The objective can be constrained by the following obvious reasons:
·
Calendar completion dates
·
Cash or cash flow restrictions
·
Limited resources
·
Approvals
In addition to this, there are also secondary objectives of scheduling:
·
Studying alternatives
·
Developing an optimal schedule
·
Using resources effectively
·
Communicating
·
Refining the estimating criteria
·
Obtaining good project control
·
Providing for easy revisions
24.4
Master Production Scheduling:
We know that master production scheduling is not a new concept. Earliest material control
systems used a "quarterly ordering system" to produce a Master Production Schedule (MPS) for
plant production.
165
Project Management ­MGMT627
VU
This system uses customer order backlogs to develop a production plan over a three-month
period. The production plan is then exploded manually to determine what parts must be
purchased or manufactured at the proper time. However, rapidly changing customer
requirements and fluctuating lead times, combined with a slow response to these changes, can
result in the disruption of master production scheduling.
24.5
Master Production Schedule (MPS) Definition:
Before going into the details, it is important to know what a Master Production Schedule (MPS)
is. A Master Production Schedule (MPS) is a statement of what will be made, how many units
will be made, and when they will be made. It is a production plan, not a sales plan. The Master
Production Schedule (MPS) considers the total demand on a plant's resources, including
finished product sales, spare (repair) part needs, and interplant needs. The Master Production
Schedule (MPS) must also consider the capacity of the plant and the requirements imposed on
vendors. Provisions are made in the overall plan for each manufacturing facility's operation. All
planning for materials, manpower, plant, equipment, and financing for the facility is driven by
the master production schedule.

Figure 24.1: Material Requirements Pl
166
Project Management ­MGMT627
VU
under severe scrutiny during the 1960s when the Department of Defense required all contractors
to submit detailed planning to such extremes that many organizations were wasting talented
people by having them serve as writers instead of doers. Since then, because of the complexity
of large programs, requirements imposed on the program plan have been eased.
In case of large and often complex programs, customers may require a program plan that
documents all activities within the program. The program plan then serves as a guideline for the
lifetime of the program and may be revised as often development programs require more
revisions to the program plan than manufacturing or construction programs). The program plan
provides the following framework:
·
Eliminates conflicts between functional managers
·
Eliminates conflicts between functional management and program management
·
Provides a standard communications tool throughout the lifetime of the program. (It should
be geared to the work breakdown structure.)
·
Provides verification that the contractor understands the customer's objectives and
requirements
·
Provides a means for identifying inconsistencies in the planning phase
·
Provides a means for early identification of problem areas and risks so that no surprises
occur downstream
Note that the development of a program plan can be time-consuming and costly. The input
requirements for the program plan depend on the size of the project and the integration of
resources and activities. All levels of the organization participate. The upper levels provide
summary information, and the lower levels provide the details. The program plan, like activity
schedules, does not preclude departments from developing their own planning.
One of the key features of the program plan is that it must identify how the company resources
will be integrated. Finalization of the program is an iterative process similar to the sequence of

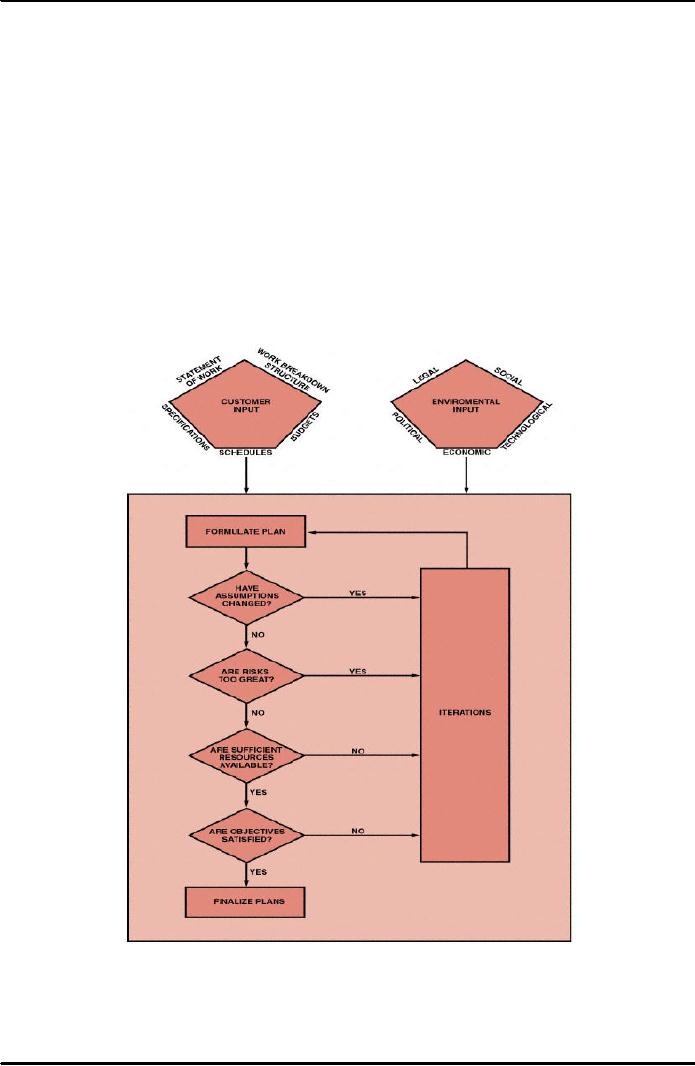

events for schedule preparation, shown in the figure 24.2 below. Since the program plan must
explain the events in the figure, additional iterations are required, which can cause changes in a
program.

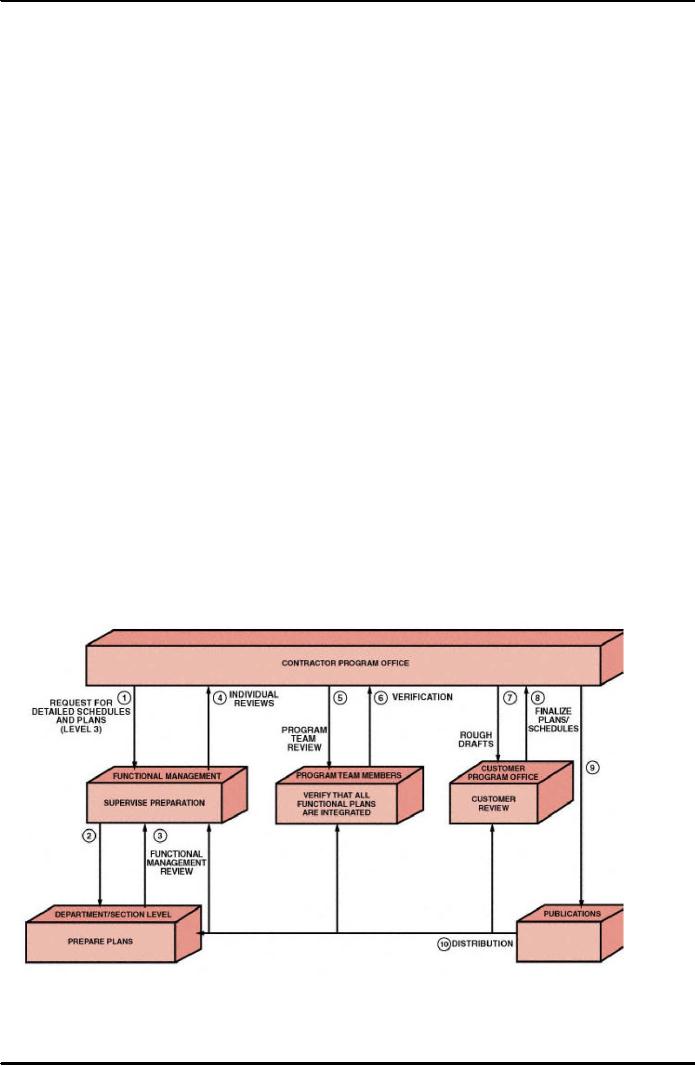

Figure 24.2:
167
Project Management ­MGMT627
VU
as a cookbook for the duration of the program by answering the following questions for all
personnel identified with the program:
·
What will be accomplished?
·
How will it be accomplished?
·
Where will it be accomplished?
·
When will it be accomplished?
·
Why will it be accomplished?
The answers to these questions force both the contractor and the customer to take a hard look at:
·  Program requirements
·  Program management
·  Program schedules
·  Facility requirements
·  Logistic support
·  Financial support
·  Manpower and organization
Figure 24.3: Iterations for the Planning Process
In addition to this, the program plan is more than just a set of instructions. It is an attempt to
eliminate crisis by preventing anything from ''falling through the cracks." The plan is
documented and approved by both the customer and the contractor to determine what data, if
168
Project Management ­MGMT627
VU
any, are missing and the probable resulting effect. As the program matures, the program plan is
revised to account for new or missing data. The most common reasons for revising a plan are:
·
"Crashing" activities to meet end dates
·
Trade-off decisions involving manpower, scheduling, and performance
·
Adjusting and leveling manpower requests
Usually the maturity of a program implies that crisis will decrease. Unfortunately, this is not always
the case.
The makeup of the program plan may vary from contractor to contractor. Most program plans
can be subdivided into four main sections:
i)
Introduction
ii)
Summary and conclusions
iii)
Management
iv)
Technical
The complexity of the information is usually up to the discretion of the contractor, provided that
customer requirements, as may be specified in the statement of work, are satisfied.
To begin with, the introductory section contains the definition of the program and the major
parts involved. If the program follows another, or is an outgrowth of similar activities, this is
indicated, together with a brief summary of the background and history behind the project.
The second section that is the summary and conclusion section identifies the targets and
objectives of the program and includes the necessary "lip service" on how successful the
program will be and how all problems can be overcome. This section must also include the
program master schedule showing how all projects and activities are related. The total program
master schedule should include the following:
·
An appropriate scheduling system (bar charts, milestone charts, network, etc.)
·
A listing of activities at the project level or lower
·
The possible interrelationships between activities (can be accomplished by logic networks,
critical path networks, or PERT networks)
·
Activity time estimates (a natural result of the item above)
As already mentioned, the summary and conclusion chapter is usually the second section in the
program plan so that upper-level customer management can have a complete overview of the
program without having to search through the technical information.
The third section, that is the management section of the program plan contains procedures,
charts, and schedules as follows:
·
The assignment of key personnel to the program is indicated. This usually refers only to the
program office personnel and team members, since under normal operations these will be
the only individuals interfacing with customers.
·
Manpower, planning, and training are discussed to assure customers that qualified people
will be available from the functional units.
·
A linear responsibility chart might also be included to identify to customers the authority
relationships that will exist in the program.
169
Project Management ­MGMT627
VU
There exist some situations in which the management section may be omitted from the
proposal. For a follow-up program, the customer may not require this section if management's
positions are unchanged.
In addition to this, the management sections are also not required if the management
information was previously provided in the proposal or if the customer and contractor have
continuous business dealings.
The fourth section that is the technical section may include as much as 75 to 90 percent of the
program plan, especially if the effort includes research and development. The technical section
may require constant updating as the program matures. The following items can be included as
part of the technical section:
·
Detailed breakdown of the charts and schedules used in the program master schedule,
possibly including schedule/cost estimates.
·
Listing of the testing to be accomplished for each activity. (It is best to include the exact
testing matrices.)
·
Procedures for accomplishment of testing. This might also include a description of the key
elements in the operations or manufacturing plans as well as a listing of the facility and
logistic requirements.
·
Identification of materials and material specifications. (This might also include system
specifications.)
·
An attempt to identify the risks associated with specific technical requirements (not
commonly included). This assessment tends to scare management personnel who are
unfamiliar with the technical procedures, so it should be omitted if at all possible.
Therefore, the program plan contains a description of all phases of the program. For many
programs, especially large ones, detailed planning is required for all major events and activities.
The following Table 24.1 identifies the type of individual plans that may be required in place of
a (total) program plan. However, the amount of detail must be controlled, for too much
paperwork can easily inhibit successful management of a program.

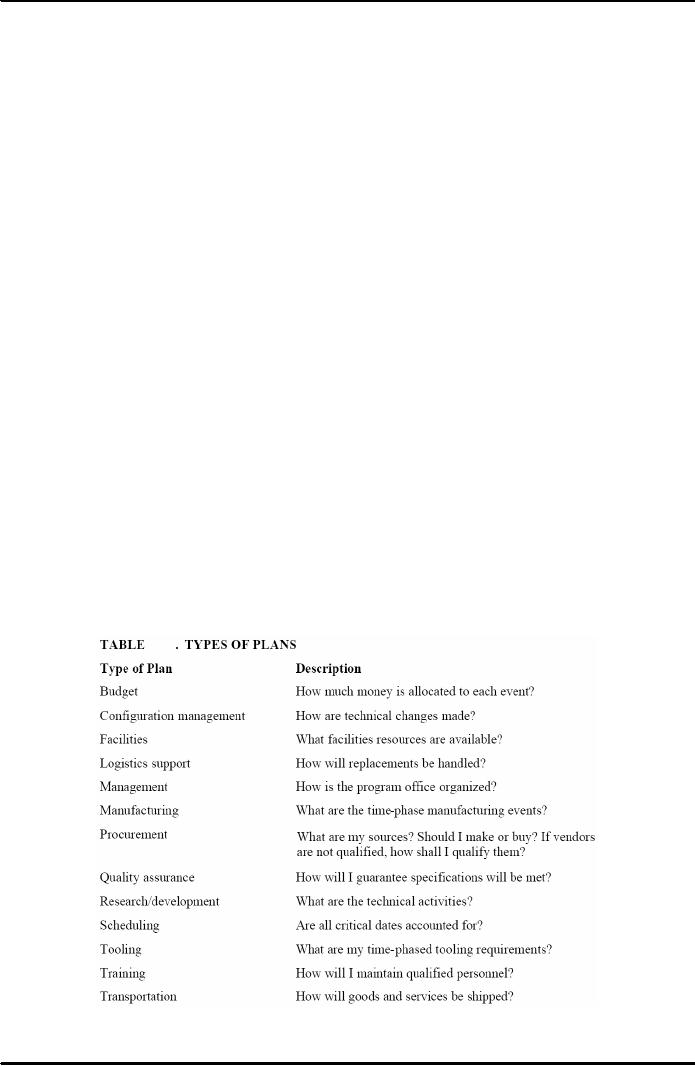

Table 24.1: Types of Plans
170
Project Management ­MGMT627
VU
Once agreed on by the contractor and customer, the program plan is then used to provide
program direction. This is shown in the figure 24.4 below. If the program plan is written clearly,
then any functional manager or supervisor should be able to identify what is expected of him.
Note that the program plan should be distributed to each member of the program team, all
functional managers and supervisors interfacing with the program, and all key functional
personnel. The program plan does not contain all of the answers, for if it did, there would be no
need for a program office. The plan serves merely as a guide.

Figure 24.4: Program Direction Activities
Here we conclude with a final note that the program plan may be specified contractually to
satisfy certain requirements as identified in the customer's statement of work. The contractor
retains the right to decide how to accomplish this, unless, of course, this is also identified in the
Statement of Work (SOW). If the Statement of Work (SOW) specifies that quality assurance
testing will be accomplished on fifteen end-items from the production line, then fifteen is the
minimum number that must be tested. The program plan may show that twenty-five items are to
be tested. If the contractor develops cost overrun problems, he may wish to revert to the
Statement of Work (SOW) and test only fifteen items. Contractually, he may do this without
informing the customer. In most cases, however, the customer is notified, and the program is
revised.
171
Table of Contents:
  1. INTRODUCTION TO PROJECT MANAGEMENT:Broad Contents, Functions of Management
  2. CONCEPTS, DEFINITIONS AND NATURE OF PROJECTS:Why Projects are initiated?, Project Participants
  3. CONCEPTS OF PROJECT MANAGEMENT:THE PROJECT MANAGEMENT SYSTEM, Managerial Skills
  4. PROJECT MANAGEMENT METHODOLOGIES AND ORGANIZATIONAL STRUCTURES:Systems, Programs, and Projects
  5. PROJECT LIFE CYCLES:Conceptual Phase, Implementation Phase, Engineering Project
  6. THE PROJECT MANAGER:Team Building Skills, Conflict Resolution Skills, Organizing
  7. THE PROJECT MANAGER (CONTD.):Project Champions, Project Authority Breakdown
  8. PROJECT CONCEPTION AND PROJECT FEASIBILITY:Feasibility Analysis
  9. PROJECT FEASIBILITY (CONTD.):Scope of Feasibility Analysis, Project Impacts
  10. PROJECT FEASIBILITY (CONTD.):Operations and Production, Sales and Marketing
  11. PROJECT SELECTION:Modeling, The Operating Necessity, The Competitive Necessity
  12. PROJECT SELECTION (CONTD.):Payback Period, Internal Rate of Return (IRR)
  13. PROJECT PROPOSAL:Preparation for Future Proposal, Proposal Effort
  14. PROJECT PROPOSAL (CONTD.):Background on the Opportunity, Costs, Resources Required
  15. PROJECT PLANNING:Planning of Execution, Operations, Installation and Use
  16. PROJECT PLANNING (CONTD.):Outside Clients, Quality Control Planning
  17. PROJECT PLANNING (CONTD.):Elements of a Project Plan, Potential Problems
  18. PROJECT PLANNING (CONTD.):Sorting Out Project, Project Mission, Categories of Planning
  19. PROJECT PLANNING (CONTD.):Identifying Strategic Project Variables, Competitive Resources
  20. PROJECT PLANNING (CONTD.):Responsibilities of Key Players, Line manager will define
  21. PROJECT PLANNING (CONTD.):The Statement of Work (Sow)
  22. WORK BREAKDOWN STRUCTURE:Characteristics of Work Package
  23. WORK BREAKDOWN STRUCTURE:Why Do Plans Fail?
  24. SCHEDULES AND CHARTS:Master Production Scheduling, Program Plan
  25. TOTAL PROJECT PLANNING:Management Control, Project Fast-Tracking
  26. PROJECT SCOPE MANAGEMENT:Why is Scope Important?, Scope Management Plan
  27. PROJECT SCOPE MANAGEMENT:Project Scope Definition, Scope Change Control
  28. NETWORK SCHEDULING TECHNIQUES:Historical Evolution of Networks, Dummy Activities
  29. NETWORK SCHEDULING TECHNIQUES:Slack Time Calculation, Network Re-planning
  30. NETWORK SCHEDULING TECHNIQUES:Total PERT/CPM Planning, PERT/CPM Problem Areas
  31. PRICING AND ESTIMATION:GLOBAL PRICING STRATEGIES, TYPES OF ESTIMATES
  32. PRICING AND ESTIMATION (CONTD.):LABOR DISTRIBUTIONS, OVERHEAD RATES
  33. PRICING AND ESTIMATION (CONTD.):MATERIALS/SUPPORT COSTS, PRICING OUT THE WORK
  34. QUALITY IN PROJECT MANAGEMENT:Value-Based Perspective, Customer-Driven Quality
  35. QUALITY IN PROJECT MANAGEMENT (CONTD.):Total Quality Management
  36. PRINCIPLES OF TOTAL QUALITY:EMPOWERMENT, COST OF QUALITY
  37. CUSTOMER FOCUSED PROJECT MANAGEMENT:Threshold Attributes
  38. QUALITY IMPROVEMENT TOOLS:Data Tables, Identify the problem, Random method
  39. PROJECT EFFECTIVENESS THROUGH ENHANCED PRODUCTIVITY:Messages of Productivity, Productivity Improvement
  40. COST MANAGEMENT AND CONTROL IN PROJECTS:Project benefits, Understanding Control
  41. COST MANAGEMENT AND CONTROL IN PROJECTS:Variance, Depreciation
  42. PROJECT MANAGEMENT THROUGH LEADERSHIP:The Tasks of Leadership, The Job of a Leader
  43. COMMUNICATION IN THE PROJECT MANAGEMENT:Cost of Correspondence, CHANNEL
  44. PROJECT RISK MANAGEMENT:Components of Risk, Categories of Risk, Risk Planning
  45. PROJECT PROCUREMENT, CONTRACT MANAGEMENT, AND ETHICS IN PROJECT MANAGEMENT:Procurement Cycles
