|
|||||
Project
Management MGMT627
VU
LESSON
11
PROJECT
SELECTION
Broad
Contents
Introduction
Project
decisions
Types
of project selection models
Criteria
for choosing project
model
The
nature of project selection models
Numeric
and non-numeric models
11.1
Introduction:
Project
selection is the process
of choosing a project or set of
projects to be implemented
by
the
organization. Since projects
in general require a substantial investment in
terms of money
and
resources, both of which are
limited, it is of vital importance
that the projects that an
organization
selects provide good returns on the
resources and capital invested.
This
requirement
must be balanced with the need
for an organization to move
forward and develop.
The
high level of uncertainty in the modern
business environment has
made this area of
project
management
crucial to the continued success of an
organization with the difference
between
choosing
good projects and poor projects literally
representing the difference between
operational
life and death.
Because
a successful model must capture
every critical aspect of the
decision, more complex
decisions
typically require more sophisticated models.
"There is a simple solution to
every
complex
problem; unfortunately, it is wrong".
This reality creates a major
challenge for tool
designers.
Project decisions are often high-stakes,
dynamic decisions with complex
technical
issues--precisely
the kinds of decisions that are
most difficult to
model:
ˇ
Project
selection decisions are high-stakes because of
their strategic implications.
The
projects
a company chooses can define the products
it supplies, the work it does, and
the
direction
it takes in the marketplace. Thus, project decisions
can impact every
business
stakeholder,
including customers, employees, partners,
regulators, and shareholders. A
sophisticated
model may be needed to capture strategic
implications.
ˇ
Project
decisions are dynamic because a
project may be conducted over several
budgeting
cycles,
with repeated opportunities to
slow, accelerate, re-scale, or
terminate the project.
Also,
a successful project may produce
new assets or products that
create time-varying
financial
returns and other impacts over
many years. A more sophisticated model is
needed
to
address dynamic impacts.
ˇ
Project
decisions typically produce many
different types of impacts on the
organization. For
example,
a project might increase revenue or
reduce future costs. It
might impact how
customers
or investors perceive the organization. It
might provide new capability
or
learning,
important to future success.
Making good choices requires
not just estimating
the
financial
return on investment; it requires
understanding all of the ways that
projects add
value.
A more sophisticated model is needed to
account for all of the
different types of
potential
impacts that project selection decisions
can create.
89
Project
Management MGMT627
VU
11.2
Project
Decisions:
Project
decisions often entail risk
and uncertainty. The
significance of a project risk
depends on
the
nature of that risk and on the other
risks that the organization is taking. A
more sophisticated
model
is needed to correctly deal
with risk and
uncertainty.
Project
selection is the process of evaluating
individual projects or groups of projects, and
then
choosing
to implement some set of them so
that the objectives of the parent
organization will be
achieved.
This same systematic process
can be applied to any area
of the organization's
business
in which choices must be
made between competing alternatives.
For example:
ˇ
A
manufacturing firm can use
evaluation/selection techniques to choose
which machine to
adopt
in a part-fabrication process.
ˇ
A
television station can
select which of several syndicated comedy
shows to rerun in its
7:30
p.m. weekday time-slot
ˇ
A
construction firm can select
the best subset of a large
group of potential projects on
which
to
bid
ˇ
A
hospital can find the best
mix of psychiatric, orthopedic,
obstetric, and other beds
for a
new
wing.
Each
project will have different
costs, benefits, and risks. Rarely
are these known with
certainty.
In
the face of such differences, the
selection of one project out of a
set is a difficult task.
Choosing
a number of different projects, a portfolio, is
even more complex. In the
following
sections,
we discuss several techniques that can be
used to help senior managers
select projects.
Project
selection is only one of many decisions
associated with project
management.
To
deal with all of these
problems, we use decision
aiding models. We
need such models
because
they abstract the relevant
issues about a problem from
the plethora of detail in
which
the
problem is embedded. Reality is
far too complex to deal
with in its entirety. An
"idealist" is
needed
to strip away almost all the
reality from a problem,
leaving only the aspects of the
"real"
situation
with which he or she wishes
to deal. This process of
carving away the unwanted
reality
from
the bones of a problem is called
modeling
the problem. The
idealized version of the
problem
that results is called a
model.
The
model represents the problem's
structure,
its
form. Every problem has a
form, though often
we
may not understand a problem
well enough to describe its
structure. We will use
many
models
in this book--graphs, analogies, diagrams, as
well as flow
graph and network models
to
help
solve scheduling problems, and symbolic
(mathematical)
models for a number of purposes.
Models
may be quite simple to understand, or
they may be extremely
complex. In general,
introducing
more reality into a model
tends to make the model more
difficult to manipulate. If
the
input data for a model
are not known precisely, we
often use probabilistic
information; that
is,
the model is said to be stochastic
rather
than deterministic.
Again,
in general, stochastic models are more
difficult to manipulate. We live in the
midst of
what
has been called the
"knowledge explosion." We frequently
hear comments such as
"90
percent
of all we know about physics
has been discovered since
Albert Einstein published
his
original
work on special relativity"; and
"80 percent of what we know
about the human body
has
been discovered in the past 50 years." In
addition, evidence is cited to show that
knowledge
is
growing exponentially.
Such
statements emphasize the importance of
the management
of change. To
survive, firms
should
develop strategies for
assessing and reassessing the use of
their resources.
Every
allocation
of resources is an investment in the
future. Because of the complex nature of
most
strategies,
many of these investments are in
projects.
To
cite one of many possible examples, special
visual effects accomplished through
computer
animation
are common in the movies and television
shows we watch daily. A few
years ago
90
Project
Management MGMT627
VU
they
were unknown. When the capability was in
its idea stage, computer
companies as well as
the
firms producing movies and
television shows faced the decision
whether or not to invest
in
the
development of these techniques.
Obviously valuable as the idea
seems today, the choice
was
not quite so clear a decade
ago when an entertainment company
compared investment in
computer
animation to alternative investments in a
new star, a new rock group,
or a new theme
park.
The
proper choice of investment projects is
crucial to the long-run survival of
every firm. Daily
we
witness the results of both good
and bad investment choices. In
our daily newspapers
we
read
of Cisco System's decision to purchase
firms that have developed
valuable communication
network
software rather than to
develop its own software. We
read of Procter and Gamble's
decision
to invest heavily in marketing
its products on the Internet; British
Airways' decision to
purchase
passenger planes from Airbus
instead of from its traditional
supplier, Boeing; or
problems
faced by school systems when they update
student computer labs--should they
invest
in
Windows-based systems or stick with
their traditional choice, AppleŽ.
But can such
important
choices be made rationally?
Once made, do they ever
change, and if so, how?
These
questions
reflect the need for
effective selection models.
Within
the limits of their capabilities,
such models can be used to
increase profits,
select
investments
for limited capital
resources, or improve the competitive
position of the
organization.
They can be used for
ongoing evaluation as well as
initial selection, and thus, are
a
key to the allocation and
reallocation of the organization's scarce
resources.
11.2.1
Modeling:
A
model is an object or concept, which
attempts to capture certain aspects of
the real
world.
The purpose of models can
vary widely, they can be
used to test ideas, to
help
teach
or explain new concepts to
people or simply as decorations. Since the
uses that
models
can be put are so many it is
difficult to find a definition
that is both clear and
conveys
all the meanings of the word. In the
context of project selection the
following
definition
is useful:
"A
model is an explicit statement of our
image of reality. It is a representation of
the
relevant
aspects of the decision with
which we are concerned. It represents the
decision
area
by structuring and formalizing the
information we possess about the
decision and,
in
doing so, presents reality
in a simplified organized form. A model,
therefore,
provides
us with an abstraction of a more complex
reality".
(Cooke and Slack,
1991)
When
project selection models are seen
from this perspective it is clear that
the need for
them
arises from the fact that it
is impossible to consider the environment,
within which
a
project will be implemented, in
its entirety. The challenge
for a good project
selection
model
is therefore clear. It must
balance the need to keep enough
information from the
real
world to make a good choice with the
need to simplify the situation
sufficiently to
make
it possible to come to a conclusion in a
reasonable length of
time.
11.3
Criteria
for Choosing Project
Model:
When
a firm chooses a project selection
model, the following criteria,
based on Souder (1973),
are
most important:
1.
Realism:
The
model should reflect the
reality of the manager's decision
situation, including the
multiple
objectives of both the firm and
its managers. Without a common
measurement
system,
direct comparison of different projects is
impossible.
For
example, Project A may strengthen a
firm's market share by
extending its
facilities,
and
Project B might improve its
competitive position by strengthening
its technical
staff.
Other things being equal,
which is better? The model
should take into account
the
91
Project
Management MGMT627
VU
realities
of the firm's limitations on facilities,
capital, personnel, and so forth.
The
model
should also include factors
that reflect project risks,
including the technical risks
of
performance, cost, and time as
well as the market risks of customer
rejection and
other
implementation risks.
2.
Capability:
The
model should be sophisticated enough to
deal with multiple time
periods, simulate
various
situations both internal and
external to the project (for
example, strikes, interest
rate
changes), and optimize the
decision. An optimizing model
will make the
comparisons
that management deems
important, consider major risks and constraints
on
the
projects, and then select the best
overall project or set of
projects.
3.
Flexibility:
The
model should give valid
results within the range of conditions
that the firm might
experience.
It should have the ability to be easily
modified, or to be self-adjusting
in
response
to changes in the firm's environment;
for example, tax laws
change, new
technological
advancements alter risk
levels, and, above all, the
organization's goals
change.
4.
Ease
of Use:
The
model should be reasonably convenient,
not take a long time to
execute, and be
easy
to use and understand. It should not
require special interpretation, data
that are
difficult
to acquire, excessive personnel, or unavailable
equipment. The
model's
variables
should also relate
one-to-one with those
real-world parameters, the
managers
believe
significant to the project. Finally, it
should be easy to simulate the
expected
outcomes
associated with investments in different
project portfolios.
5.
Cost:
Data
gathering and modeling costs
should be low relative to the
cost of the
project
and
must surely be less than the
potential benefits of the project. All
costs should be
considered,
including the costs of data
management and of running the
model.
Here,
we would also add a sixth
criterion:
6.
Easy
Computerization:
It
should be easy and convenient to gather
and store the information in a
computer
database,
and to manipulate data in the model
through use of a widely
available,
standard
computer package such as Excel,
Lotus 1-2-3, Quattro Pro, and
like programs.
The
same ease and convenience should
apply to transferring the information to
any
standard
decision support system.
In
what follows, we first
examine fundamental types of project
selection models and the
characteristics
that make any model more or
less acceptable. Next we consider
the
limitations,
strengths, and weaknesses of
project selection models, including
some
suggestions
of factors to consider when making a
decision about which, if
any, of the
project
selection models to use. We then
discuss the problem of selecting projects
when
high
levels of uncertainty about
outcomes, costs, schedules, or
technology are
present,
as
well as some ways of managing the risks
associated with the
uncertainties.
Finally,
we comment on some special aspects of the
information base required
for
project
selection. Then we turn our
attention to the selection of a set of projects to
help
the
organization achieve its goals and
illustrate this with a
technique called the Project
Portfolio
Process. We
finish the chapter with a discussion of
project proposals.
11.4
The
Nature of Project Selection
Models:
92
Project
Management MGMT627
VU
There
are two basic types of
project selection models, numeric
and
nonnumeric. Both
are
widely
used. Many organizations use
both at the same time, or
they use models that
are
combinations
of the two. Nonnumeric models, as the
name implies, do not use
numbers as
inputs.
Numeric models do, but the
criteria being measured may
be either objective or
subjective.
It is important to remember that the
qualities
of
a project may be represented
by
numbers,
and that subjective
measures
are not necessarily less
useful or reliable than
objective
measures.
Before
examining specific kinds of models
within the two basic types,
let us consider just
what
we
wish the model to do for us,
never forgetting two
critically important, but
often overlooked
facts.
ˇ
Models
do not make decisions--people
do. The manager, not the
model, bears
responsibility
for the decision. The
manager may "delegate" the
task of making the
decision
to
a model, but the responsibility cannot be
abdicated.
ˇ
All
models, however sophisticated, are only
partial representations of the reality
they are
meant
to reflect. Reality is far
too complex for us to capture more
than a small fraction of
it
in
any model. Therefore, no
model can yield an optimal
decision except within its
own,
possibly
inadequate, framework.
We
seek a model to assist us in
making project selection decisions. This
model should possess
the
characteristics discussed previously and,
above all, it should evaluate
potential projects by
the
degree to which they will
meet the firm's objectives. To construct
a selection/evaluation
model,
therefore, it is necessary to develop a
list of the firm's
objectives.
A
list of objectives should be
generated by the organization's top
management. It is a direct
expression
of organizational philosophy and policy.
The list should go beyond
the typical
clichés
about "survival" and "maximizing
profits," which are
certainly real goals but are
just as
certainly
not the only goals of the firm.
Other objectives might
include maintenance of share of
specific
markets, development of an improved image
with specific clients or
competitors,
expansion
into a new line of business,
decrease in sensitivity to business
cycles, maintenance of
employment
for specific categories of
workers, and maintenance of system
loading at or above
some
percent of capacity, just to mention a
few.
A
model of some sort is implied by
any conscious decision. The
choice between two or more
alternative
courses of action requires reference to
some objective(s), and the choice is
thus,
made
in accord with some,
possibly subjective, "model." Since the
development of computers
and
the establishment of operations research as an
academic subject in the mid-1950s, the
use of
formal,
numeric models to assist in decision
making has expanded. Many of
these models use
financial
metrics such as profits and/or
cash flow to measure the "correctness" of
a managerial
decision.
Project selection decisions are no
exception, being based
primarily on the degree to
which
the financial goals of the organization
are met. As we will see
later, this stress on
financial
goals, largely to the exclusion of other
criteria, raises some
serious problems for the
firm,
irrespective of whether the firm is
for profit or
not-for-profit.
When
the list of objectives has
been developed, an additional
refinement is recommended.
The
elements
in the list should be weighted.
Each
item is added to the list
because it represents a
contribution
to the success of the organization, but
each item does not
make an equal
contribution.
The weights reflect
different degrees of contribution
each element makes in
accomplishing
a set of goals.
Once
the list of goals has been
developed, one more task remains. The
probable contribution of
each
project to each of the goals should be
estimated. A project is selected or rejected
because it
is
predicted to have certain outcomes if
implemented.
93
Project
Management MGMT627
VU
These
outcomes are expected to contribute to
goal achievement. If the estimated level of
goal
achievement
is sufficiently large, the project is
selected. If not, it is rejected.
The
relationship between the project's expected
results and the organization's goals must
be
understood.
In general, the kinds of information
required to evaluate a project
can be listed
under
production, marketing, financial,
personnel, administrative, and other such
categories.
The
following table 11.1 is a
list of factors that contribute,
positively or negatively, to
these
categories.
In
order to give focus to this
list, we assume that the
projects in question involve the
possible
substitution
of a new production process
for an existing one. The
list is meant to be
illustrative.
It
certainly is not
exhaustive.

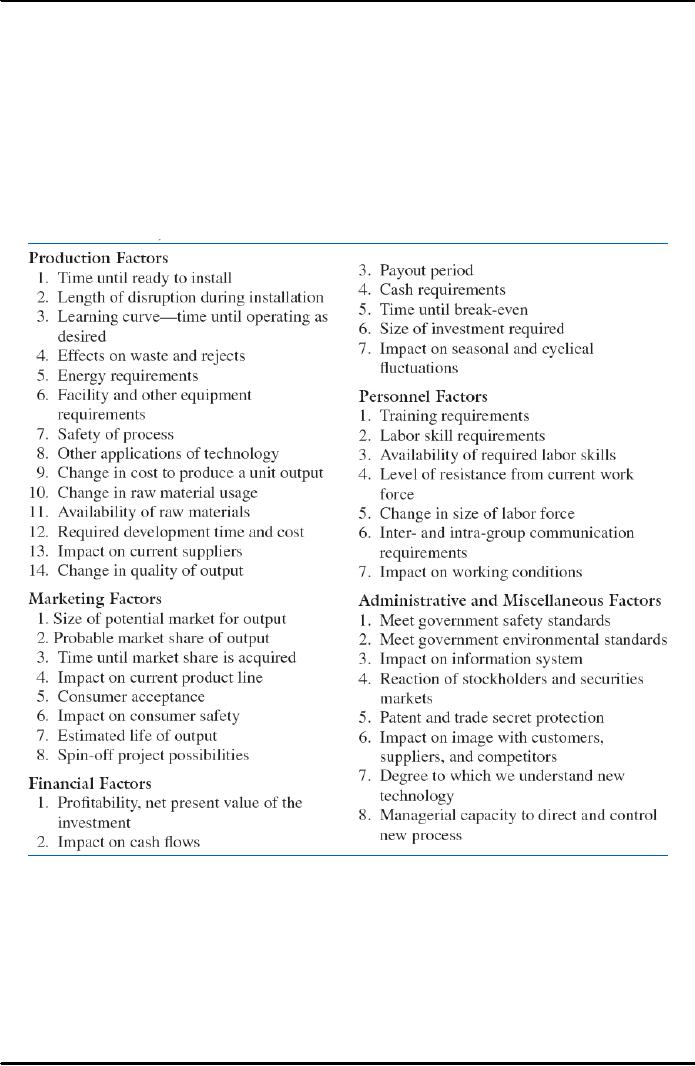

Table
11.1: Factors Contributing to Various
Organizational Categories
Some
factors in this list have a one-time
impact and some recur.
Some are difficult to
estimate
and
may be subject to considerable error. For
these, it is helpful to identify a
range
of
uncertainty.
In
addition, the factors may occur at
different times.
And
some factors may have thresholds,
critical
values above or below which we might
wish to
reject
the project. We will deal in more
detail with these issues
later in this chapter.
94
Project
Management MGMT627
VU
Clearly,
no single project decision
needs to include all these
factors. Moreover, not only is
the
list
incomplete, it also contains redundant
items. Perhaps more important, the factors
are not at
the
same level of generality:
profitability
and
impact
on organizational image both
affect the
overall
organization, but impact
on working conditions is more
oriented to the production
system.
Nor are all elements of
equal importance.
Change
in production cost is
usually considered more important than
impact
on current
suppliers.
Shortly,
we will consider the problem of
generating an acceptable list of factors
and
measuring
their relative importance. At
that time we will discuss
the creation of a Decision
Support
System (DSS) for project
evaluation and selection.
The
same subject will arise once
more in the next lecture(s) when we consider
project auditing,
evaluation,
and termination.
Although
the process of evaluating a potential
project is time-consuming and difficult,
its
importance
cannot be overstated. A major consulting
firm has argued (Booz,
Allen, and
Hamilton,
1966) that the primary cause
for the failure of Research
and Development (R and
D)
projects
is insufficient care in evaluating the
proposal before the expenditure of funds.
What is
true
for such projects also
appears to be true for other
kinds of projects, and it is clear
that
product
development projects are more successful
if they incorporate user
needs and satisfaction
in
the design process (Matzler and
Hinterhuber, 1998). Careful analysis of a
potential project is
a
sine
qua non for
profitability in the construction
business. There are many
horror stories
(Meredith,
1981) about firms that
undertook projects for the installation
of a computer
information
system without sufficient analysis of the
time, cost, and disruption
involved.
Later,
we will consider the problem of
conducting an evaluation under
conditions of uncertainty
about
the outcomes associated with a
project. Before dealing with
this problem, however,
it
helps
to examine several different
evaluation/selection models and consider their
strengths and
weaknesses.
Recall that the problem of choosing the
project selection model itself
will also be
discussed
later.
11.5
Types
of Project Selection Models:
Of
the two basic types of selection models
(numeric and nonnumeric), nonnumeric
models are
older
and simpler and have only a few
subtypes to consider. We examine them
first.
ˇ
Non-Numeric
Models:
These
include the following:
1.
The Sacred
Cow:
In
this case the project is
suggested by a senior and powerful
official in the
organization.
Often the project is initiated
with a simple comment such
as, "If you have
a
chance, why don't you
look into . . .," and there
follows an undeveloped idea
for a
new
product, for the development of a
new market, for the design and
adoption of a
global
database and information system, or
for some other project
requiring an
investment
of the firm's resources. The
immediate result of this
bland statement is the
creation
of a "project" to investigate whatever
the boss has
suggested.
The
project is "sacred" in the sense
that it will be maintained
until successfully
concluded,
or until the boss, personally,
recognizes the idea as a failure
and
terminates
it.
2.
The
Operating Necessity:
If
a flood is threatening the plant, a
project to build a protective
dike does not
require
much formal evaluation,
which is an example of this
scenario. XYZ
Steel
Corporation has used this
criterion (and the following
criterion also) in
evaluating
potential projects. If the project is
required in order to keep the
95
Project
Management MGMT627
VU
system
operating, the primary question
becomes: Is the system worth
saving at
the
estimated cost of the project? If the
answer is yes, project costs
will be
examined
to make sure they are
kept as low as is consistent
with project
success,
but the project will be
funded.
3.
The
Competitive Necessity:
Using
this criterion, XYZ Steel undertook a
major plant rebuilding
project in
the
late 1960s in its steel bar
manufacturing facilities near
Chicago. It had
become
apparent to XYZ's management that the
company's bar mill
needed
modernization
if the firm was to maintain
its competitive position in
the
Chicago
market area. Although the
planning process for the
project was quite
sophisticated,
the decision to undertake the project
was based on a desire
to
maintain
the company's competitive position in
that market.
In
a similar manner, many business
schools are restructuring
their
undergraduate
and Masters in Business Administration (MBA) programs
to
stay
competitive with the more forward
looking schools. In large
part, this
action
is driven by declining numbers of
tuition paying students and
the need to
develop
stronger programs to attract them.
Investment
in an operating
necessity project
takes precedence over
a
competitive
necessity project,
but both types of projects may
bypass the more
careful
numeric analysis used for projects
deemed to be less urgent or
less
important
to the survival of the firm.
4.
The
Product Line Extension:
In
this case, a project to
develop and distribute new products
would be judged
on
the degree to which it fits the
firm's existing product
line, fills a gap,
strengthens
a weak link, or extends the
line in a new, desirable
direction.
Sometimes
careful calculations of profitability
are not required.
Decision
makers
can act on their beliefs
about what will be the
likely impact on the
total
system
performance if the new product is added
to the line.
5.
Comparative
Benefit Model:
For
this situation, assume that
an organization has many projects to
consider,
perhaps
several dozen. Senior management
would like to select a
subset of the
projects
that would most benefit the
firm, but the projects do not
seem to be
easily
comparable. For example, some projects
concern potential new
products,
some
concern changes in production
methods, others concern
computerization
of
certain records, and still
others cover a variety of
subjects not easily
categorized
(e.g., a proposal to create a daycare
center for employees with
small
children).
The
organization has no formal method of
selecting projects, but members of
the
selection committee think that some
projects will benefit the firm more
than
others,
even if they have no precise way to
define or measure
"benefit."
The
concept of comparative benefits, if
not a formal model, is
widely adopted
for
selection decisions on all sorts of projects.
Most United Way
organizations
use
the concept to make decisions about which
of several social programs to
fund.
Senior management of the funding
organization then examines
all
projects
with positive recommendations and
attempts to construct a portfolio
that
best fits the organization's
aims and its budget.
96
Table of Contents:
|
|||||
